Bond Measures E and H, passed in 1998, provided funds for much-needed renovation and modernization of schools within the Santa Cruz City Schools District. Overall, the Grand Jury found school site personnel pleased with the work completed at their schools, and acknowledges the scope and complexity of the construction projects undertaken in the last eight years. Those projects, however, took longer and cost more than original estimates, and students are now occupying classrooms that have not been certified by the Division of the State Architect as being in compliance with all Code of Regulations, Title 24 provisions for structural, life/fire safety, and ADA projects.
The Grand Jury discovered that Measure E bonds were sold for more than the voter-approved $28 million, and questions remain about the 2005 bond refinancing. The Grand Jury is concerned that: bond money was spent on district administrative offices; lease revenues generated from sites that were renovated using bond funds went into the Santa Cruz City Schools general fund; bond funds and property tax deposits have earned and will continue to earn interest that could be used to reduce bond debt; and promises to keep the public well-informed about the bond projects have not been kept.
ADA: Americans with Disabilities Act
Alternate: an optional component of a construction project
BAN: Bond
Anticipation Note; a note issued in anticipation of later issuance of bonds,
usually payable from the proceeds of the sale of the bonds anticipated
BOC: Santa Cruz City Schools Bond Oversight Committee
California Code of Regulations (CCR), Title 24: also known as the California Building Standards Code. Public school construction in California is governed by these building standards.
Change Order: a written order that modifies the plans, specifications, or price of a signed construction contract agreement. Change orders can be initiated for a variety of reasons, including unforeseen conditions, owner-requested changes, design errors or omissions, contractor error, and weather-related problems during construction.
DSA: Division of the State Architect
DSA
Form-5: the official DSA form that
details the project inspector’s qualifications
IOR: Inspector of Record; a state-certified inspector that performs state-mandated site inspection services for public school construction and who is hired and paid by the owner (school district)
Multiple-prime contracting: the owner (school district) holds separate contracts with contractors of various disciplines (such as general, mechanical, electrical). The owner, or its construction manager, manages the overall schedule and budget during the entire construction phase.
RFP: Request for Proposal; an invitation to bid, or a proposal inviting bids from possible suppliers of a product or service
SB50: the 1998 state bond measure that provided matching funds to the Santa Cruz City Schools District for modernization projects. District matching funds were generated from Bond Measures E and H.
SCCS: Santa Cruz City Schools
SCCS Bond Project,
Status of Project Closeout, May 10, 2006: This was the version of the summary document detailing construction
costs, change orders, and project completion dates that the Grand Jury used for
this report.
Stop Notice: a notice to withhold payment from a
contractor and to set money aside to satisfy a claim

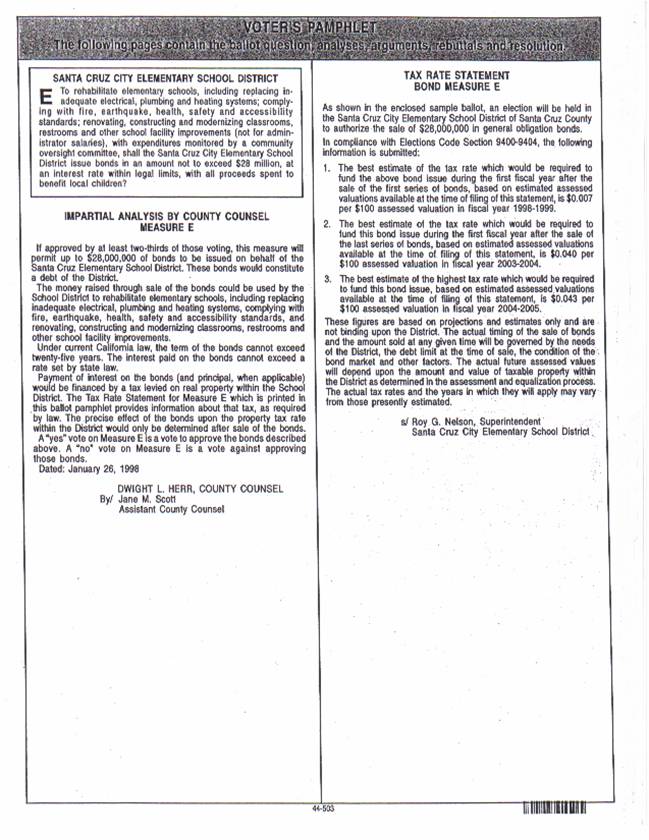

In April 1998, voters in the Santa Cruz City Schools (SCCS) District passed two bond measures worth a total of $86 million. The district spent over $300,000 for this special election for Measure E and Measure H that was held just seven weeks prior to the regularly scheduled June primary election.[1]

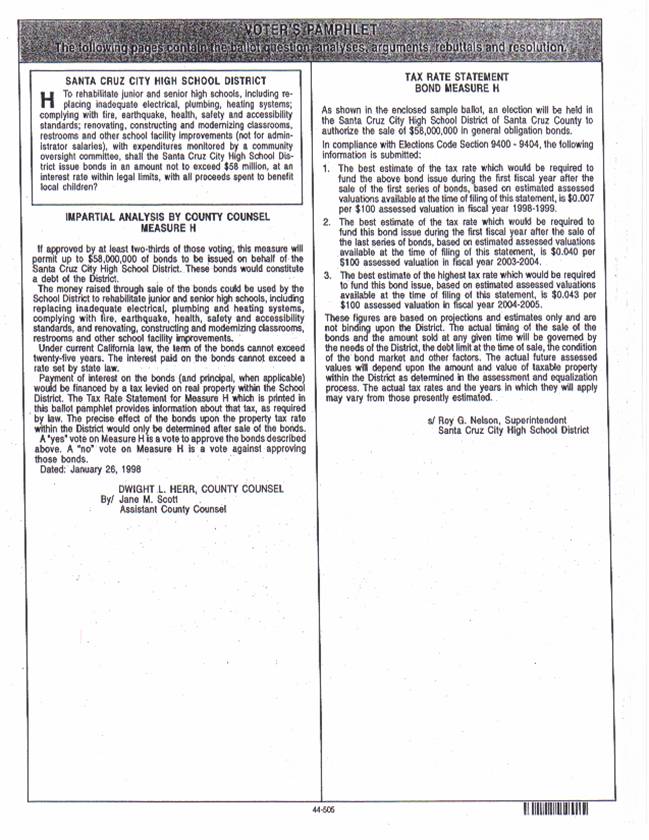

Measure E, approved by seventy-nine percent (79%) of the voters, was for elementary school improvements not to exceed $28 million, and Measure H, approved by seventy-four percent (74%) of the voters, was for junior and senior high school improvements not to exceed $58 million. The measures stated that the bond money would be used to rehabilitate the schools, including replacing inadequate electrical, plumbing, heating, and window systems; to comply with fire, earthquake, health, safety, and accessibility standards; and to renovate, construct, and modernize classrooms, restrooms, and other school facility improvements. Bond money would not be used for administrator salaries. Expenditures would be monitored by a community bond oversight committee, with all proceeds spent to benefit district schools. All elementary and secondary school sites in the district were included in the bond measures.

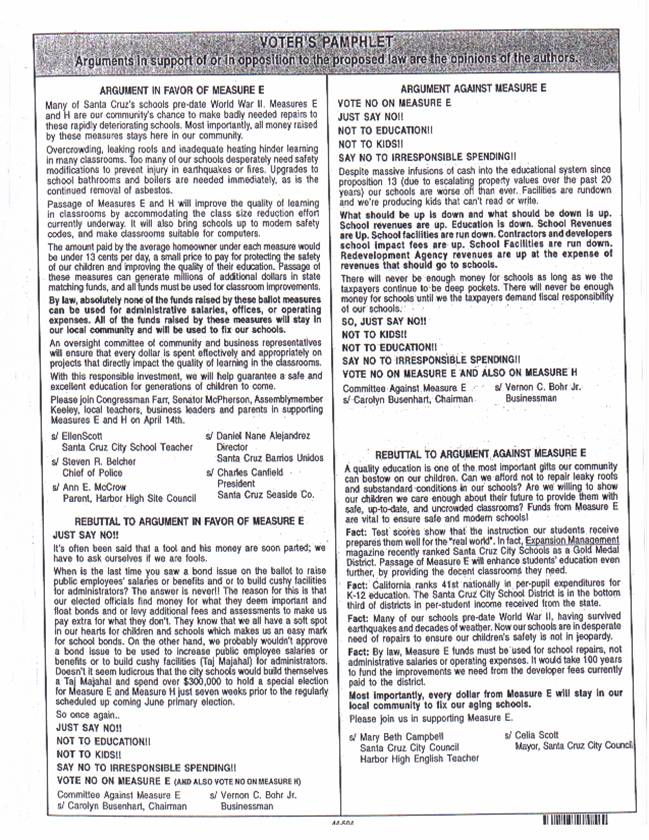

Voter Information Pamphlet arguments in favor of
Measures E and H stated that “By law, absolutely none of the funds raised by
these ballot measures can be used for administrative salaries, offices, or
operating expenses. All of the funds raised by these measures will stay in our
local community and will be used to fix our schools.”[2]
The E and H bonds were originally each sold in three series:
A, B, and C. Series A was sold in 1998, Series B in 2000, and Series C in 200l. According
to the Voter Information Pamphlet, “Impartial Analysis by County Counsel,” the
term for each bond sale was to be 25 years, which was the maximum term under
California law when the measures were passed. On April 13, 2005, the SCCS Board
of Education passed resolutions authorizing the refinancing of the general
obligation Bond Measures E and H, Series A and B to take advantage of decreased
interest rates. This refinancing did not require voter approval.
As each series was sold, the money from the sale was deposited into the Santa Cruz County Treasury to be withdrawn by the Santa Cruz City Schools District as needed for the bond projects. As property taxes are collected, they are also deposited in the County Treasury. These funds are withdrawn to make payments to the bond holders.
The Santa Cruz County Assessor’s Office establishes the rate that each property owner in the Santa Cruz City Schools District must pay toward the bonds. For the tax year 2005-2006, the rate is:[3]
At this rate, taxes resulting from Bond Measures E and H on property within the City of Santa Cruz with an assessed value of $300,000 would be $243 for the 2005-2006 tax year. Property owners outside the city limits, but within the high school district, would pay only the high school percentage, or .039%.
The school renovation projects were not funded solely by the proceeds of bonds E and H sales. Under the State Construction Program, the district applied in 1999 for SB50 (State Bond 50) funds for modernization that it began receiving in July 2000. These state funds were earmarked for renovation of schools that met the age requirement for modernization (twenty-five years or older). This was a cash-matching program, and E and H funds were used for the match. The district received over $28 million from the state. Additions including bond interest, developer fees, deferred maintenance funds, and donations brought the total revenue for bond projects to $128,683,715 as of April 30, 2006. Total revenue for the bond projects is summarized as follows:[4]
REVENUE SOURCE |
REVENUE AMOUNT |
Bond Proceeds |
|
Series A (6/98) |
$21,854,000 |
Series B (3/00) |
$46,300,077 |
BAN Funds (Series C, 10/00) |
$15,990,000 |
Series C (10/01) |
$110,171 |
Subtotal Bond Proceeds |
$84,254,248 |
Other Revenue |
|
Bond Interest |
$10,411,303 |
Bond Arbitrage Liability |
($419,412) |
BAN Interest |
$976,905 |
BAN Arbitrage Liability |
($210,905) |
Deferred Maintenance |
$974,499 |
Food Services |
$175,000 |
Capital Facilities Fund |
$2,597,047 |
State SB-50 Rel. 1 |
$1,906,616 |
State SB-50 Rel. 2 |
$26,514,241 |
SB-50 Interest |
$620,037 |
Grants |
$345,024 |
Donations |
$231,801 |
Insurance Reimb (Pool Deck) |
$122,748 |
Building Fund |
$19,814 |
General Fund |
$164,749 |
Subtotal Other Revenue |
$44,429,467 |
TOTAL REVENUE |
$128,683,715 |
Table 1. Revenue, SCCS Bond Projects
Budget, July 1, 1998 to
April 30, 2006.
Prior to the bond campaign, a Facility Assessment Team comprised of construction professionals and district staff evaluated each of the school sites, worked with site and district staff in developing a needs assessment, prioritized each site’s needs, and developed a cost estimate for needed and desired school construction projects. This facilities audit, along with community input, was used by the district to determine the amount of money that was requested in the bond election. Although approximately $130 million in needed and desired improvements were identified, a community survey indicated voters would be willing to support bonds totaling $86 million. Projects were prioritized based on the $86 million figure, and renovations and repairs addressing code requirements, health and safety concerns, and systems projects such as roofing, electrical, and plumbing were given priority.
After the election, district staff, together with architects
and construction managers, developed a Master Schedule to accomplish the
Facility Assessment projects. The schedule defined the sequence for planning
and construction of the projects at each school site from June 1999 through
December 2003. The schedule was discussed with all site principals and the Bond
Oversight Committee. Within the Master Schedule, each school site was listed
along with an anticipated planning and construction timeline. The work at each
school site was divided into the following tasks: pre-design, design, state
review, bidding, and construction.
In the “Road to Renovation” pamphlet mailed out by SCCS in May 2000 to residents within the SCCS boundaries, it was stated that the construction schedule called for all projects to be completed by the end of the 2003-2004 school year. Due to state funding and additional revenues, in May 2003, with SCCS Board approval, site planning committees began meeting to identify and prioritize additional modernization projects at each school site. As of June 2006, there are still three projects to be bid, and eighteen projects under construction. Projects may extend well beyond the end of 2006.
Bond projects were originally overseen by the Director of Bond Projects, a district administrative position, to provide general oversight and management of the program. Two architect/construction management teams (DES-WLC Architects/Turner Construction Management for the elementary schools, and Beverly Prior/Kitchell Construction Management for the secondary schools) assisted. Projects were put out to bid for multiple prime contractors, that is, a prime contractor for each trade. Due to the difficulty in managing multiple and separate contracts, missed work, and instances of poor work quality, the district discontinued its use of multiple prime contractors.
The bond projects are now managed by district staff and contracted firms. The organizational components for project management include:
· the Assistant Superintendent, Business Services, providing district administration oversight;
· general contractors bidding for projects;
· a construction management firm providing overall program management for bond projects (Strategic Construction Management);
· two architecture firms, one for the elementary and junior high schools (DES Architects), and one for the high schools (Beverly Prior Architects), providing design services and project administration;
· Inspectors of Record providing state-mandated site inspection services; and
· district employees (3.2 positions) paid by bond funds: a full-time district Construction Project Coordinator, a full-time clerical support person; a full-time accounting person; and support from the district purchasing manager for bidding and contracting processes.
In California, public school construction is governed by the California Public Contract Code. Construction contracts must be awarded to the lowest responsible bidder as defined in these code sections:[5]

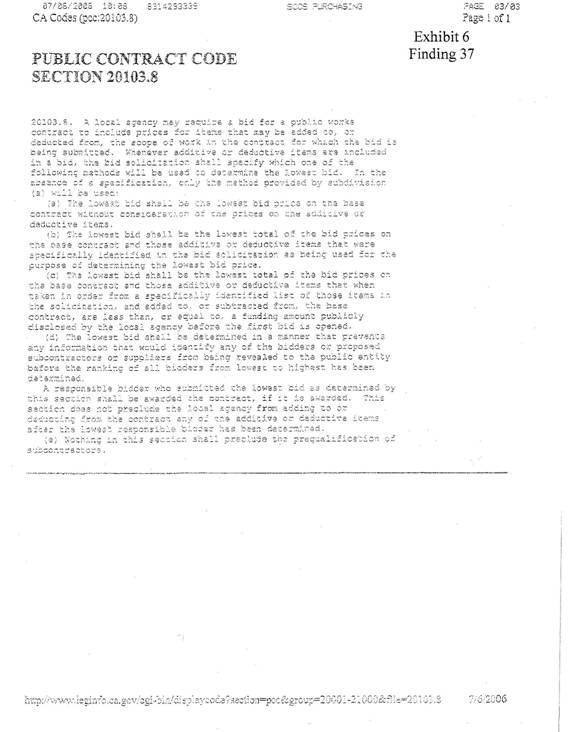

“Responsible bidder,” as used in this part, means a bidder who has demonstrated the attribute of trustworthiness, as well as quality, fitness, capacity, and experience to satisfactorily perform the public works contract. (Section 1103)
On the day named in the public notice, the department shall publicly open the sealed bids and award the contracts to the lowest responsible bidders. (Section 10180)
SCCS District officials stated that the lowest, responsive,
responsible bidder is hired by the district. A responsive bidder is one that
has provided all necessary documents and meets all specified qualifications in
a timely manner.
When construction projects are put out to bid, a Request for Proposal (RFP) is published in the newspaper, and interested contractors are invited to submit bids by a specified date. On that date, the bids are publicly opened, recorded, and awarded to the lowest, responsive, responsible bidder.
The Division of the State Architect (DSA) reviews all
public school construction involving structural, fire/life safety, and ADA
compliance projects. Construction plans and documents drafted by the district’s
hired architects and engineers are submitted to the DSA for plan checking to
make sure they conform to the California Code of Regulations, Title 24. After
plans are checked and approved, they are stamped with an identification stamp,
and are ready for the construction phase. When a project is under construction,
it is supervised by DSA field operations. Field engineers go to the site to
make sure plans are being followed and work is up to code. The field engineer
receives reports from state-certified Inspectors of Record (IOR) at least twice
a month. The IORs make sure work is performed
according to the DSA-approved documents. Public school construction is not
inspected by city and county building inspectors, but by state-certified
inspectors.
Once a project is completed, a Notice of Completion is
recorded at the County Recorder’s office and is publicized. The project
closeout process then begins. The DSA reviews all required project
documentation to verify that all work was performed and inspected in accordance
with code requirements. If documentation indicates that construction met these
requirements, the DSA issues a Letter of Certification to the school district.
If documentation is incomplete, the DSA sends the Architect of Record a letter,
with a ninety-day deadline to submit all remaining documents. If these
documents are not submitted, the project is closed without DSA certification.
The file can be reopened when documentation is complete, but a fee of $150 for
each project is assessed.
In Fall 1998, a committee consisting
of volunteer community members was formed by the district to provide oversight
for the bond projects. The Bond Oversight Committee (BOC) is an advisory body
only and makes recommendations to the school board. Final authority for all
aspects of the bond measures resides with the SCCS Board of Trustees. The BOC
meets every other month and receives reports on financial and construction
status; reviews standard bid documents and change orders; reviews contracts for
design, construction management, construction contractors, and contract
amendments; and has been involved in the reallocation of dollars between school
sites. Specified roles and responsibilities include attending all committee
meetings; becoming familiar with the laws, regulations, and processes that the
school district must satisfy in completing the projects authorized by the bond;
and working with all interested parties to facilitate communication about the
status of the bond projects.[6]
According to district officials, by the end of Summer 2006,
ninety-eight percent (98%) of the bond funds will have been spent as projects
are nearing completion. The BOC’s final meeting is scheduled for November 2006.
A subcommittee has been established to work with school district staff and
Strategic Construction Management to prepare a final report on the bond projects
for the board and community members, detailing how both time and money were
spent under Measures E and H.
This investigation was undertaken to review financial documentation for the Santa Cruz City Schools Bond Measures E and H. The investigation included:
As the investigation progressed, the bond details and issues of project management, bidding, and oversight were also examined.
Santa Cruz City Schools District personnel.
Bond Oversight Committee members.
Division of the State Architect personnel.
Santa Cruz County personnel.
Advantages/Disadvantages of Using Multiple Prime v. Single General Contractor, agenda packet, Bond Oversight Committee meeting, January 27, 2000.
California Department of General Services, Division of the State Architect, Project Inspector Qualification Record, DSA-5, revised March 27, 2003.
Communications Matrix for Bond Projects Participants, November 29, 2001.
IOR Bi-Monthly Progress Reports, Santa Cruz High, May 2002.
Memo from Northcross, Hill and Ach, June 8, 2006.
Official Statements, Santa Cruz City Elementary School District, General Obligation Bonds, Election of 1998, Series A, B, and C.
Official Statements, Santa Cruz City High School District, General Obligation Bonds, Election of 1998, Series A, B, and C.
Official Statement, Santa Cruz City Elementary School District, 2005 General Obligation Refunding Bonds.
Official Statement, Santa Cruz City High School District, 2005 General Obligation Refunding Bonds.

Santa Cruz City Schools, Agreement for Consultant Services, Construction Program Management Services, Strategic Construction Management, February 1, 2002.
Santa Cruz City Schools, Board of Education for the Elementary and Secondary Districts Minutes, May 12, 1999 to May 10, 2006. [Please see Appendix for specific dates.]
Santa Cruz City School Bond Oversight Committee Meeting Minutes, May 16, 1998 to May 18, 2006. [Please see Appendix for specific dates.]
Santa Cruz City Schools “Bond Oversight
Committee Roles and Responsibilities,” revised April 17, 2002.

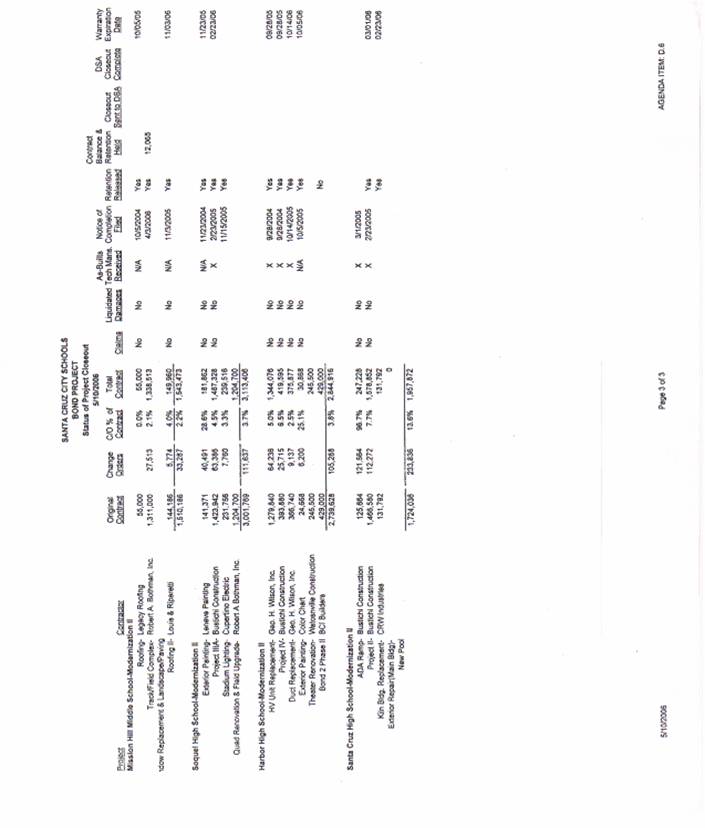

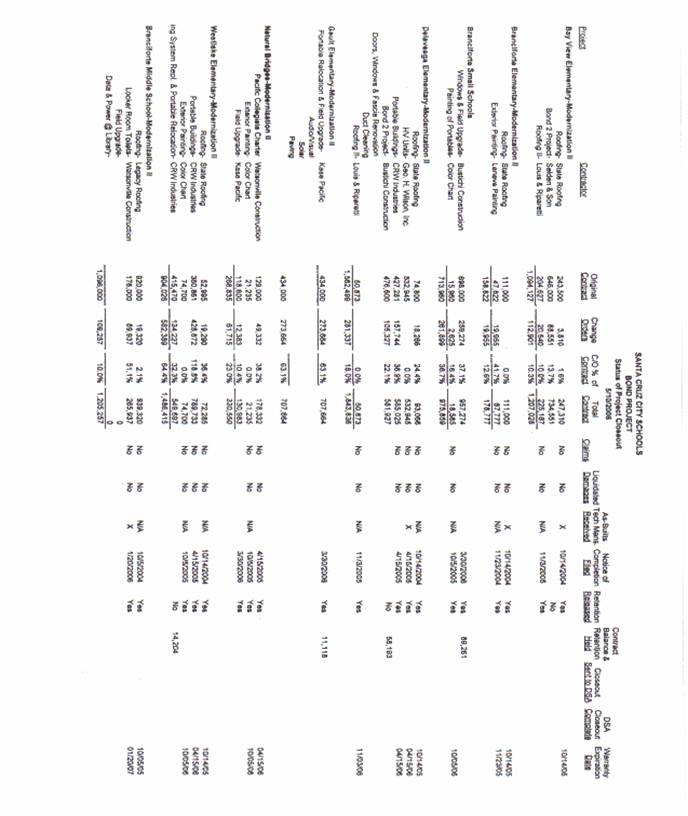

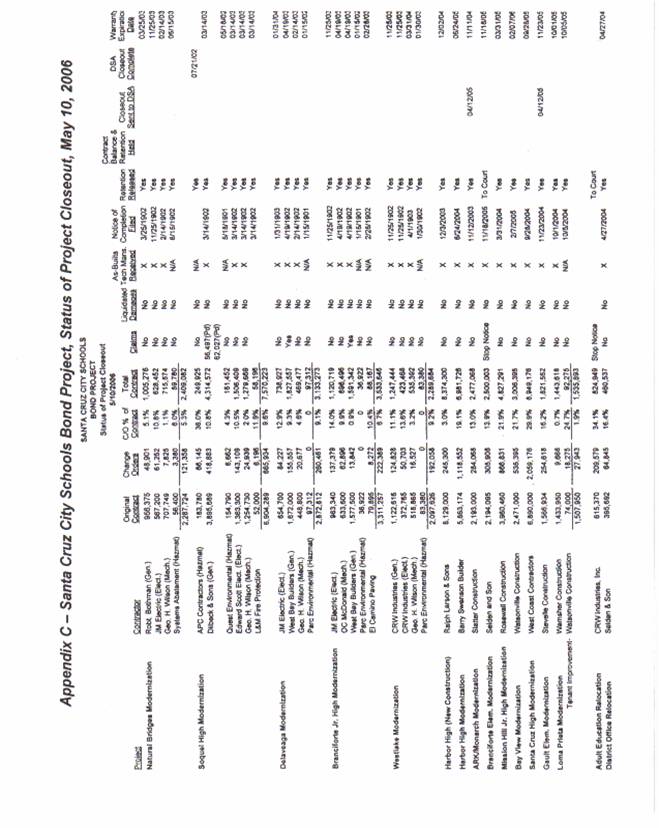

Santa Cruz City Schools Bond Project, Status
of Project Closeout, May 10, 2006.
Santa Cruz City Schools, Bond Projects

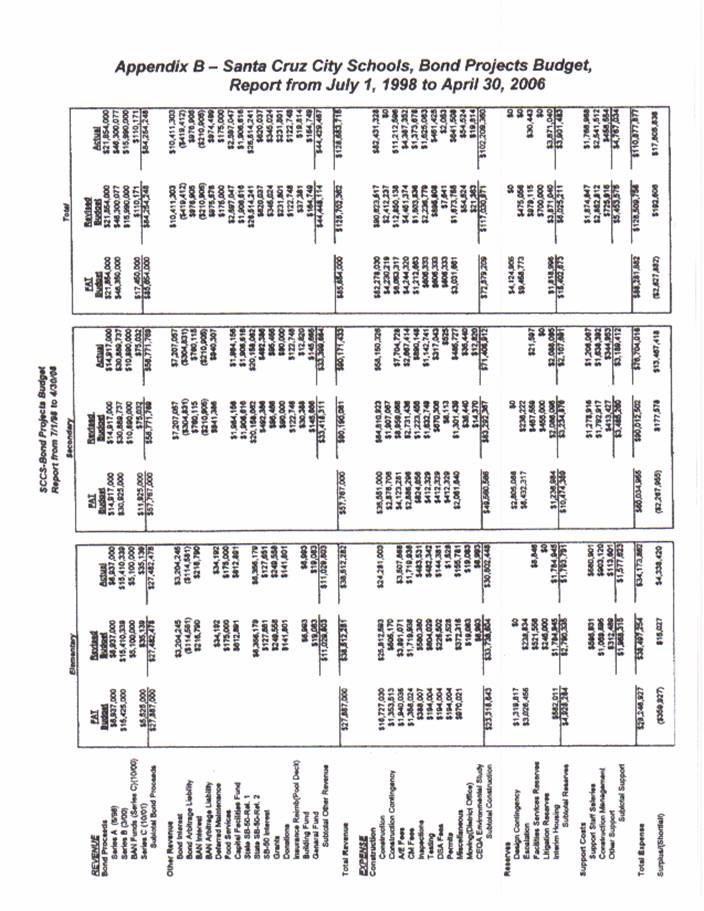

Budget, Report from July 1, 1998 to April 30, 2006.
Santa Cruz City Schools District Bond
Projects Status Reports, November 17, 1999 to January 25, 2006. [Please see
Appendix for specific dates.]
Santa Cruz City Schools, Request for
Proposals, Management Services for Construction Projects, undated.

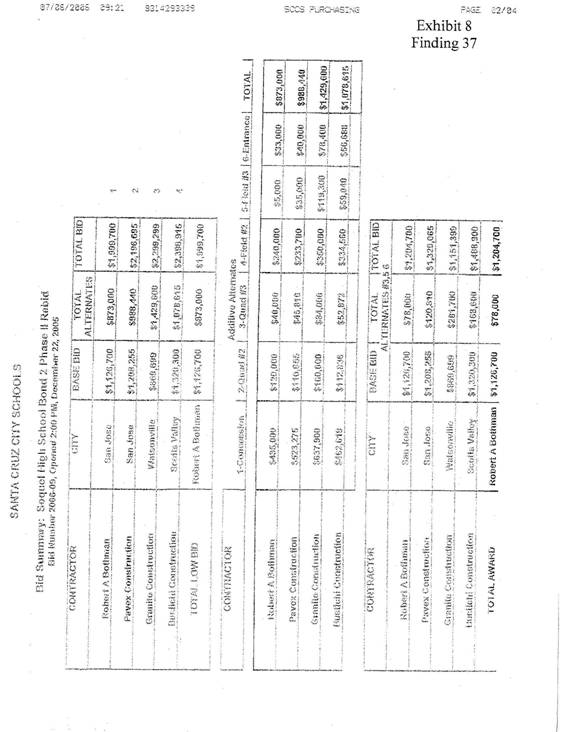

Soquel High School Bond II Modernization Project IIIA, Bid #2004-21, Opened June 3, 2004.
Soquel High School Bond 2 Phase II Rebid, Bid #2006-09, Opened December 22, 2005.
Contra Costa Times, “Schools’ refinancing questioned,” April 30, 2006.
County of Santa Cruz Sample Ballot and Voter Information Pamphlet for Special School District Election, Tuesday, April 14, 1998.
“Road to Renovation: Keeping You Informed,” Santa Cruz City Schools, undated.
Santa Cruz Sentinel:
“Bond-funded school repairs set to start in Santa Cruz,” May 13, 1999.
“Bonds making a difference,” March 22, 2001.
“Branciforte remodeling project disappoints staff,” October 14, 2001.
“Error could cost schools thousands,” April 8, 2005.
“Firm will oversee school construction projects,” February 15, 2002.
“Moving costs stir school-bond debate,” May 29, 2003.
“Santa Cruz City Schools finds surplus in general fund,” April 20, 2006.
“Students say last goodbye to Natural Bridges, Branciforte schools,” June 12, 2004.
Building Standards Commission, http://www.bsc.ca.gov.
California Code of Regulations, http://www.bsc.ca.gov/title_24/documents/part1/2001_part1.pdf.
California Education Code, http://caselaw.lp.findlaw.com/cacodes/edc/15200-15205.html.
California State Constitution, http://www.leginfo.ca.gov/const.html.
California Public Contract Code, http://www.aroundthecapitol.com/code/contents.html?sec=pcc.
“Choosing the Best Delivery Method for Your Facility Projects,” http://www.mbpce.com/news_pubs_delivery.html.
Division of the State Architect, http://www.dsa.dgs.ca.gov.
Division of the State Architect On-Line Project Tracking System, http://www.applications.dgs.ca.gov/dsa/etrackerweb/DistrictProject.asp?clientid=44-h2 and http://www.applications.dgs.ca.gov/dsa/etrackerweb/DistrictProject.asp?clientid=44-42.
General Obligation Bonds, http://www.calschools.com/static/GOBond.htm.
Santa Cruz City Schools, http://www.sccs.santacruz.k12.ca.us.
Santa Cruz City Schools, Bond Projects, http://www.sccs.santacruz.k12.ca.us/bizservices/BondProject/bondproject.htm (this web site is no longer accessible).
Santa Cruz County Office of Education, http://www.santacruz.k12.ca.us/board/index.html.
Santa Cruz Sentinel, http://www.santacruzsentinel.com.
State Education Oversight Commissions, http://www.ecs.org/clearinghouse/57/86/5786.htm.
Strategic Construction Management, http://strategic-cm.com/main/santacruzcityschools.htm.
TBW&B, Public Finance Strategies, LLC, http://www.tbwb.com/clients.htm.
2001 California Building Standards Administrative Code, California Code of Regulations, Title 24, Part 1, http://www.bsc.ca.gov/title_24/documents/Part1/2001_part1.pdf.
Ten Santa Cruz City School sites.
1. The E and H bonds were originally each sold in three series: A, B, and C:[7]
Bond Sold |
Date |
Bond Amount |
Bond Term Ends |
Series A, Elementary |
July 1, 1998 |
$7,000,000.00 |
August 1, 2027 |
Series B, Elementary |
March 1, 2000 |
$15,500,000.00 |
August 1, 2029 |
Series C, Elementary |
October 2001 |
$5,598,115.65 |
February 1, 2026 |
TOTAL ELEM. |
|
$28,098,115.65 |
|
Series A, High School |
July 1, 1998 |
$15,000,000.00 |
August 1, 2027 |
Series B, High School |
March 1, 2000 |
$31,000,000.00 |
August 1, 2029 |
Series C, High School |
October 2001 |
$11,997,433.50 |
February 1, 2026 |
TOTAL HIGH SCH. |
|
$57,997,433.50 |
|
In April 2005, Series A and B Elementary and High School bonds were refinanced:
Refinance, Series A and B, Elementary |
April 2005 |
$22,785,000 |
August 1, 2029 |
Refinance, Series A and B, High School |
April 2005 |
$45,500,000 |
August 1, 2029 |
Table 2. Santa Cruz City Schools Bond Sales, Measures E and H.
2.
Total Elementary bond sales, Series A, B, and C
exceeded the $28 million dollar cap established in Bond Measure E.
Response: Santa Cruz County Auditor-Controller AGREES.
Response: Santa Cruz City Schools AGREES.
3.
When asked about exceeding the $28 million cap on the
Elementary bonds, district administrative staff referred the Grand Jury’s
questions to the district’s bond financial advisor, Northcross,
Hill and Ach. The Grand Jury was told, “Unintentionally, $98,115.65 was issued
in bonds over the 28 million dollar amount approved by the voters. The district
has made provision to repay the $98,115.65 and all interest that has accrued.”
The amount of the interest earned is unknown to the Grand Jury.
Response: Santa Cruz County Auditor-Controller AGREES.
Response: Santa Cruz City Schools AGREES.
Initial drafts of the bond authorization for the Santa Cruz
City Elementary School District (County of Santa Cruz, California) General
Obligation Bonds, Election of 1998, proposed a maximum authorization of $28.1
million. When adopted, the resolution authorizing the bonds provided for a
maximum of $28 million (the additional $100,000 amount was inadvertently
omitted). It was assumed, upon the issuance of each series, that the authorized
amount was $28.1 million. Upon issuance of the Series C Bonds, the $28 million
limit was exceeded by $98,115.65. This fact was discovered in early June 2006.
On June 16, 2006, the total sum of $114,325.65, $98,115.65 from the District
(representing unexpended proceeds of the Series C Bonds), $8,105.00 from the
District’s financial advisor and $8,105.00 from the District’s bond counsel,
was deposited with the paying agent and invested in U.S. Treasury Securities and
held for the payment of the Series C Bonds. The amounts paid by the District’s
financial advisor and by the District’s bond counsel represents the total
amount paid by the taxpayers and will be used to reimburse those amounts
collected by the District for such payment.
4.
The last of the original Elementary bonds was sold in
2001, but repayment of the $98,115.65 overage has not yet been made as of June
10, 2006.
Response: Santa Cruz County Auditor-Controller AGREES.
School District staff advised the County Auditor-Controller
that the $98,115.65 overage has been returned to the District’s third party
bond paying agent on June 16, 2006, who will repay this amount at the next call
date. The Auditor-Controller has not verified
this information.
Response: Santa Cruz City Schools PARTIALLY
AGREES.
The $98,115.65 overage was repaid on 6/16/06.
5.
When Elementary and High School Bonds, Series A and B
were refinanced in April 2005, the total amount of the refunding bonds was
$4,280,000 higher than the remaining principal of the original Series A and B
bonds. The Elementary Series A and B Bonds were refinanced for $22,785,000 (the
outstanding principal was $21,030,000); the High School Series A and B Bonds
were refinanced for $45,500,000 (the outstanding principal was $42,975,000).[8]
Response: Santa Cruz County Auditor-Controller
AGREES.
Response: Santa Cruz City Schools AGREES.
6.
SCCS District’s bond financial advisor stated
that “the amount of the refunding bonds is determined by the amount needed to
establish an escrow to pay off the old bonds, which includes interest and
principal due . . . and pay the costs of issuance.”
Response: Santa Cruz County
Auditor-Controller AGREES.
The Santa Cruz County Auditor-Controller does
not know whether the District’s financial advisor made this statement, but
generally speaking, this is how the amount of refunding bonds are determined.
Response: Santa Cruz City Schools AGREES.
7.
Elementary bonds, Series C and Elementary 2005
Refunding Bonds total $28,383,115.65, again exceeding the $28 million cap
established by the bond measure.
Response: Santa Cruz County
Auditor-Controller PARTIALLY AGREES.
The elementary bonds,
Series C and Elementary 2005 refunding bonds do total $28,383,115.65. Whether
this exceeded the $28 million cap established by the bond measure is a legal
matter which the Auditor-Controller is not qualified to determine.
Response: Santa Cruz City Schools PARTIALLY
AGREES.
The issuance of refunding bonds, where the
refunding bonds bear interest at a lower rate than the refunded bonds, always
will require a higher amount of refunding bonds than refunded bonds. This is
because federal tax law limits the investment rate of the escrow created to pay
the refunded bonds to the interest rate on refunding bonds. Therefore, more
dollars are needed, at a lower rate, to pay fewer dollars at a higher rate.
This is common practice for general obligation refunding bonds. California law
specifically permits the refunding bonds to have a principal amount greater
than the bonds refunded.
Government
Code Section. 53552.
Whenever the legislative body of a local agency determines that prudent
management of the fiscal affairs of the local agency requires that it issue
refunding bonds under the provisions of this article, it may do so without
submitting the question of the issuance of the refunding bonds to a vote of the
qualified electors of the local agency . . . .
Refunding bonds shall not be issued if the total net interest cost to
maturity on the refunding bonds plus the principal amount of the refunding
bonds exceeds the total net interest cost to maturity on the bonds to be
refunded plus the principal amount of the bonds to be refunded . . . . Subject
to this limitation, the principal amount
of the refunding bonds may be more than, less than, or the same as the principal amount of the bonds to be
refunded. (emphasis added)
In all cases, the total net interest cost to
maturity on the refunding bonds plus the principal amount of the refunding
bonds is less than the total net interest cost to maturity on the bonds
refunded plus the principal amount of the bonds refunded.
8.
The April 2005 refinancing of the Elementary and High
School Bonds, Series A and B is not detailed on the
SCCS Bond Projects Budget, Report from July 1, 1998 to April 30, 2006.
Response:
Santa Cruz County Auditor-Controller DISAGREES.
School
District staff advised the Auditor-Controller that this is not an accurate
finding, but the Auditor-Controller has not verified this information. The
Auditor-Controller has no opinion.
Response: Santa Cruz City Schools DISAGREES.
The SCCS Bond
Projects Budget Report is designed to report on the status of revenue received
and available for expenditure on the construction projects and related support
costs, and the status of expenditures made from those funds. The April 2005 refinancing of the Elementary
and High School Series A and B Bonds do not appear in this budget report
because the refinancing did not result in any additional funds available to be
expended on the construction projects.
9.
According to the Official Statements for the bond
sales, property owners residing in the Santa Cruz City Schools District will be
repaying bonds E and H until 2029.
Response: Santa Cruz County Auditor-Controller
AGREES.
Response: Santa Cruz City Schools AGREES.
10. The
Voter Information Pamphlet for Bond Measures E and H contained an “impartial
analysis by County Counsel” stating that “under current California law, the
term of the bonds cannot exceed twenty-five years.”[9]
This term is also stated in the California Education Code, Section 15144: “The
number of years the whole or any part of the bonds are to run shall not exceed
25 years, from the date of the bonds or the date of any series thereof.”[10]
Response:
Santa Cruz County Auditor-Controller PARTIALLY AGREES.
The
voter information pamphlet did include this statement. California Education
Code Section 15144 authorizes bonds up to 25 years. California Government Code
authorizes bonds up to 40 years. Whether the 29 year bonds that were issued
under the Government Code are legally compliant for a School District is a
legal matter which the Auditor-Controller is not qualified to determine.
Response: Santa Cruz City Schools PARTIALLY
AGREES.
The bonds were authorized by resolution adopted
by the Governing Board, with the following stipulations:
Said bonds proposed to be
issued and sold shall bear interest at a rate not exceeding the maximum rate
allowable by law, at the time or times of the sale thereof, such interest to be
payable annually or semiannually thereafter, and the number of years the whole
or any part of the principal amount of the bonds shall be payable shall not
exceed twenty-five (25) years (or such
greater maximum term as may be permitted by law) from the date of the bonds
or the date of any series thereof. (emphasis added)
Section 53506 of the California Government Code
provides full authority for the issuance of bonds by a school district and is
intended to provide a complete additional and alternative method for doing so,
supplemental and additional to the powers conferred by any other laws. This
section authorizes the issuance of bonds for up to 40 years.
The School
District has no control over the analysis of ballot measures written by the
County Counsel, who did not mention the authority that school districts have
under the Government Code to issue general obligation bonds for terms up to 40
years. The terms on Series A and B of
Measures E and H were 28 years.
11. On
April 13, 2005, the SCCS Board of Education passed resolutions authorizing the
refinancing (refunding) of the general obligation Bond Measures E and H, Series
A and B to take advantage of decreased interest rates.
Response:
Santa Cruz County Auditor-Controller AGREES.
School
District staff advised the Auditor-Controller that this is an accurate finding,
but the Auditor-Controller has not verified this information.
Response:
Santa Cruz City Schools AGREES.
12. SCCS
District’s bond financial advisor stated that the refunding of the bonds will
result in lower debt service payments, with the majority of savings in
2006-2010, and that the refinancing will lower taxes.
Response:
Santa Cruz County Auditor-Controller PARTIALLY AGREES.
The Santa Cruz County Auditor-Controller does
not know whether the District’s financial advisor made this statement, but law
requires any debt refinancings to result in lower
annual debt service payments. The debt
service payments for the Santa Cruz City Schools Series A and B bonds were
reduced after the refinancing. Debt
service payments for A and B totaled $4,714,087 in FY 2004-05 before the
refinancing. Debt service payments were
reduced to $4,439,449 in FY 2005-06 and $4,010,865 in FY 2006-07 after
refinancing. Following is a schedule detailing
this.
|
|
2004-05 |
2005-06 |
2006-07 |
Elementary Schools |
|
|
|
|
|
A (1998) |
466,655
|
|
|
|
B (1998) |
1,083,070
|
|
|
|
A and B Total |
1,549,725
|
|
|
|
A and B
Refinanced (2005) |
1,453,347
|
1,319,610
|
|
|
|
|
|
|
|
C (1998) |
400,000
|
400,000
|
405,001
|
|
|
|
|
|
|
Total |
1,949,725
|
1,853,347
|
1,724,611
|
|
|
|
|
|
High School |
|
|
|
|
|
A (1998) |
1,002,470
|
|
|
|
B (1998) |
2,161,892
|
|
|
|
A and B Total |
3,164,362
|
|
|
|
A and B
Refinanced (2005) |
2,986,102
|
2,691,255
|
|
|
|
|
|
|
|
C (1998) |
855,000
|
855,000
|
855,751
|
|
|
|
|
|
|
Total |
4,019,362
|
3,841,102
|
3,547,006
|
|
|
|
|
|
Total Elementary and High Schools |
|
|
||
|
A (1998) |
1,469,125
|
|
|
|
B (1998) |
3,244,962
|
|
|
|
A and B Total |
4,714,087 |
|
|
|
A and B
Refinanced (2005) |
4,439,449 |
4,010,865 |
|
|
|
|
|
|
|
C (1998) |
1,255,000
|
1,255,000
|
1,260,752
|
|
|
|
|
|
|
Total |
5,969,087
|
5,694,449
|
5,271,617
|
Debt service for the refinancing bonds (A and B) will continue at approximately
$4 million until FY 2010-11, at which time it will increase to about $4.7
million, where it will remain until the bonds mature in 2029.
Response: Santa Cruz City Schools PARTIALLY
AGREES.
The
taxpayers for both the elementary school district and the high school district
will see significantly lower tax rate on the bills they receive during the fall
of 2006. These bills will be for the fiscal year 2006-07. The timing of the savings is consistent with
the statement referenced above.
13. For
tax year 2004-2005, property owners residing in the Santa Cruz City Schools
District within the City of Santa Cruz were paying property taxes at a rate of
.068% toward bonds E and H. In tax year 2005-2006, the rate increased to .081%.
Response:
Santa Cruz County Auditor-Controller AGREES.
These
property tax rates are stated correctly.
However, these rates include the Series C bonds which were not
refunded. The property tax rates for
just the Series A and B bonds (excluding the Series C bonds) were .054% for FY
2004-05 and .068% for FY 2005-2006.
There was a one time increase in the tax rates for FY 2005-06, but it
was followed by a significant decrease to .008% for FY 2006-07. The primary
reason for the one time rate increase in FY 2005-06 is because taxes are
collected in the previous fiscal year to make the August debt service payment
in the following fiscal year, further complicated by the mechanisms of the bond
refinancing and the associated reserve funds during this period. The much lower rate in FY 2006-07 compensates
for the higher rate the previous year.
In the future, the property tax rates to pay this debt service will
stabilize at below the pre-refunding rate of .054%, tracking with the total
debt service payments indicated in item 12 above.
Response: Santa Cruz City Schools PARTIALLY
AGREES.
The tax
rate is calculated by the County of Santa Cruz. The primary considerations are
the debt service on the bonds, the reserve factor established by the county and
the assessed value. Of the three factors
the district can control only the debt service on the bonds. The High
School refunding resulted in $2.5 million in total debt service savings and the
Elementary School refunding resulted in $1.2 million in total debt service
savings. In the tax year 2005-06 the
combined refundings resulted in 6,393.99 of debt
service savings. In 2006-07 the combined

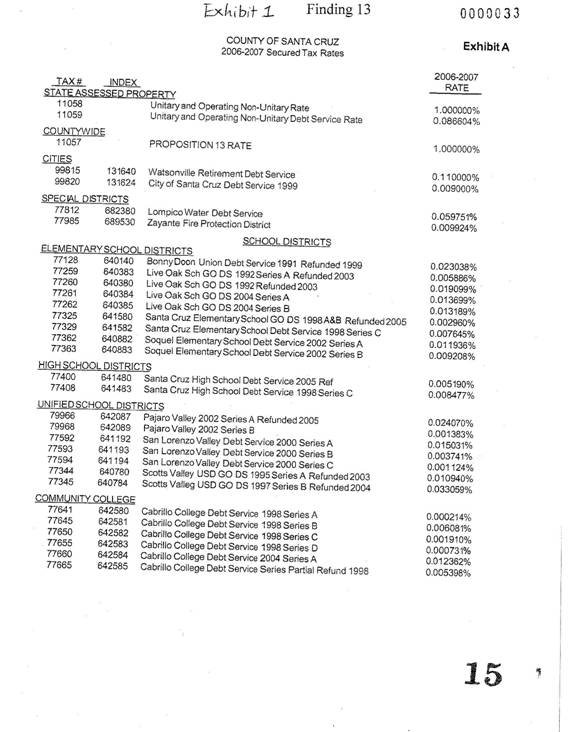

tax rate on the E and H bonds is .024272% (see Exhibit 1).
14. Interest
earned on bond sale proceeds has been used for the bond projects and has not
been used to repay the bond.[11]
Response:
Santa Cruz County Auditor-Controller AGREES.
School
District staff advised the Auditor-Controller that this is an accurate finding,
but the Auditor-Controller has not verified this information. This is a legally acceptable and common
practice.
Response:
Santa Cruz City Schools AGREES.
15. As
property tax is collected to repay bonds E and H, the money is deposited in the
pooled investment fund of the county until the district draws it out. These
deposits earn interest.
Response:
Santa Cruz County Auditor-Controller PARTIALLY AGREES
As
property tax is collected to repay bonds E and H, the money is deposited in the
County’s pooled investment fund.
However, the District does not draw the funds out of the County. Rather, the County makes the debt service
payments directly to the Bond Paying Agent.
Response: Santa Cruz City Schools PARTIALLY
AGREES.
The District does not draw the funds out of the County
pooled investment fund. The County
transfers the funds directly to the Bond Paying Agent, who uses the funds to
make interest payments to Bond holders and to retire Bonds as they come due.
16. Following is a summary of the SCCS Bond Projects Budget expenses from July 1, 1998 to April 30, 2006:[12]
ITEM |
EXPENSE |
PERCENTAGE OF EXPENSES |
Construction Contracts |
$82,431,328 |
74% |
Architects/Engineers |
$11,212,596 |
10% |
Construction Management |
$6,928,864 |
6% |
Miscellaneous Construction Costs |
$4,178,084 |
4% |
Reserves |
$3,901,483 |
4% |
Staff Salaries and Other Support |
$2,225,522 |
2% |
TOTAL EXPENSES |
$110,877,877 |
100% |

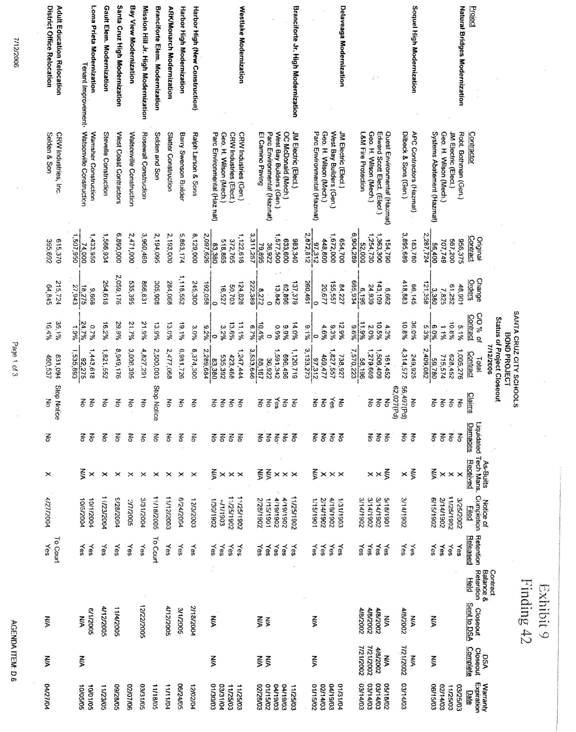

Table 3. Summary of SCCS Bond Projects
Budget Expenses, July 1, 1998 to
April 30, 2006.
17. In
January 2001, the Bond Projects staff requested authority from the school board
and the BOC to use their discretion before bidding projects in the future, and
to decide whether to bid projects with one general contractor or use
multiple-prime contractors.
18. Results
of the first four major bond projects undertaken at one high school, one junior
high school and two elementary were described as follows: “All four projects
were completed late, two of the four projects are over budget, the quality of
some of the work was sub-standard on two projects, and sub-standard work was
allowed to stand when first done, assuming it would be rectified as part of the
punch list at the end of the projects, but after many spaces had been
reoccupied. Some work that was planned to be included in some projects was left
out of the initial plans and specs and had to be added with change orders,
adding time and cost to the project.”[13]
19. At
the October 24, 2001, SCCS Board of Education meeting, district administrative
staff dissatisfaction with the ability of the construction managers to monitor
and control the work on multiple prime projects was reported. District staff
recommended:
·

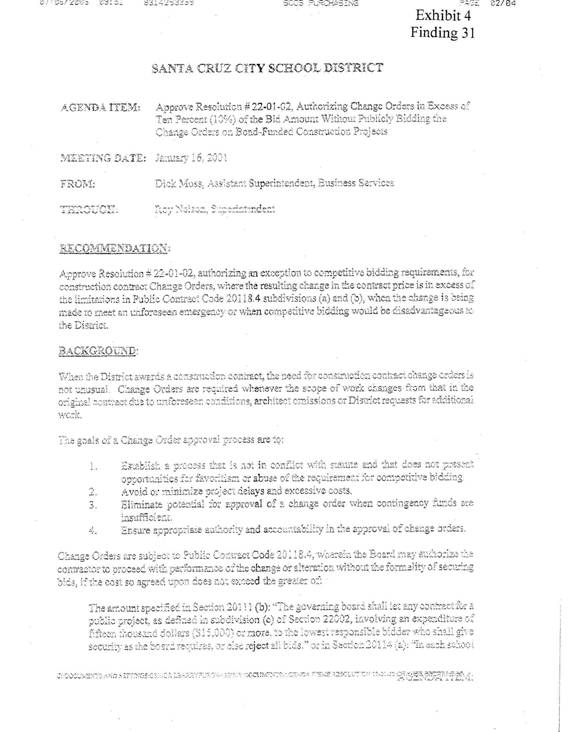

bidding future construction projects using
general contractors
·
terminating the two elementary and secondary
Construction Managers’ contracts
·
increasing Inspector of Record time on projects
to better monitor quality of work
·
increasing architect involvement in construction
administration
·
reorganizing district support and oversight of
projects
·
pre-qualifying bidders for future projects
Response: Santa Cruz City Schools AGREES.
20. District
administrative staff stated that using general contractors had the advantages
of less contract administration, total coverage of work, and direct lines of
accountability. Disadvantages were that the general contractor might not select
the lowest subcontractor bid and could charge up to a fifteen percent markup on
subcontractor change orders.[14]
District administrative staff stated that using general contractors could cost
more, but there would be clear lines of responsibility and “headaches would be
reduced.”
Response: Santa Cruz City Schools
PARTIALLY AGREES.
District administrative staff also believed that bidding
projects with General Contractors instead of multiple-prime contractors would
reduce legal costs. The District has
been involved in two construction lawsuits, both with contractors on
multiple-prime projects and none with general contractors. The clear lines of responsibility and
accountability for any construction issues are with the general contractor. When multiple-prime contractors are on a
project, the lines of responsibility and accountability can become blurred
between prime contractors.
21. On
November 15, 2001, district administrative staff reported to the BOC that the
SCCS Board had approved a plan to hire a consultant to provide general
oversight and management of the construction program. The board’s preference
was to hire professionals in the construction management field to manage future
projects, instead of having district employees in the project management role.
The board stated that it did not have confidence that district employees could
provide management, in light of the problems that had been reported by school
staff at Branciforte Junior High on that school’s projects.[15]
22. Seven
firms responded to the district’s Request for Proposal (RFP) for a construction
program manager. Three finalists were interviewed, and Strategic Construction
Management was chosen by the SCCS Board as the Construction Program Manager to
be effective February 1, 2002. District administrative staff and volunteers
stated the board liked the fact that Strategic Construction Management was
local and had ties to the community.
23. The
district has not been able to produce the fixed-price bids and requested
supporting documentation for this selection process. This documentation is
public record.

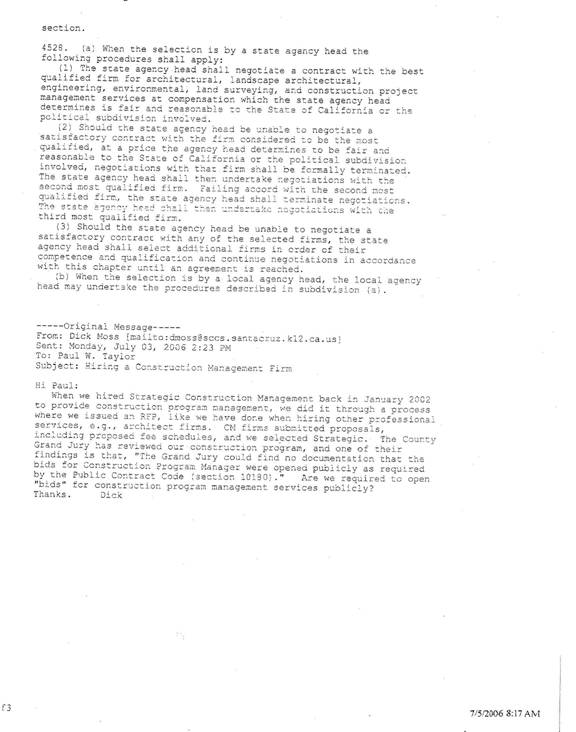

Response: Santa Cruz City Schools
PARTIALLY AGREES.
The selection of a CM firm was not a bid process. It was a Request for Proposals for selecting
professional services, for which the public bid requirements
do not apply. Four CM firms were
interviewed by the BOC Interview Committee, who ranked them as follows:
1.
Strategic CM
2.
BMR
3.
Zahn
4.
3DI
Based on hand-written notes taken by Dick Moss at the
1/17/02 BOC meeting, the fee proposals from the three firms recommended to the
Board were:
1.
Strategic CM $1,195,104,
travel @ $.365/mi. for miles greater than 100 per day, $.08/copy, reimbursables at cost +15%.
2.
BMR $1,334,000,
reimbursables at cost +10%, in-district mileage
included in base fee
3.
Zahn $2,133,930
The proposals from the CM firms were discarded when the
District Office moved from 2931 Mission Street to Soquel High School in
January, 2004.
24. The
Grand Jury could find no documentation that the bids for the Construction
Program Manager were opened publicly as required by the Public Contract Code.[16]
Response: Santa Cruz City Schools DISAGREES.
Contracting for construction management services is
contracting for professional services and is not subject to the lowest bid
requirements of the Public Contract code.
The fees for professional services are typically negotiated from a
proposal and are not bid. This process
is the same process used when hiring architects or state-certified
inspectors. According to the District’s legal
counsel on our construction program, Paul Taylor of Hefner, Stark and Marois, the District is not subject to section 10180 of the
Public Contract Code that applies to State agencies but is subject to

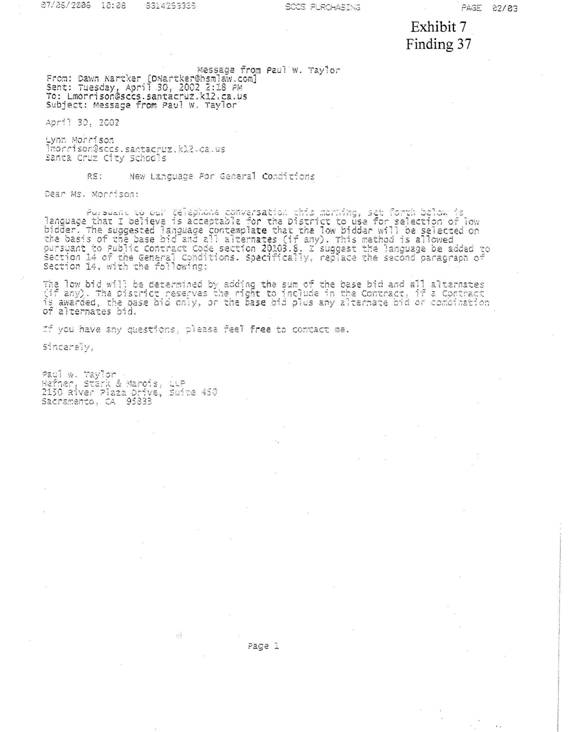

Government code section 4525 et seq. (See Exhibit 2.)
25. “Previously,
the district used its staff to oversee multiple contractors at individual
schools. Officials expect the new system, which includes hiring a general
contractor for each project, will simplify the process and attract more bids,
particularly from area contractors. The district will pay Strategic $1.2
million. District officials expect to finish all projects by December 2004.”[17]
26. Construction
Management budgets were reduced by $2,128,663 due to termination of the two
previous Construction Management contracts. Architect Fee budgets were then
increased $1,288,160 for increased services for construction administration due
to reorganization of management for the projects. These adjustments, when
combined with the new Strategic Construction Management contract for $1.2
million, produced an immediate overall increase for the bond projects of over
$360,000.
27. Since
February 1, 2002, there have been numerous contract extensions and additional
payments approved for Strategic Construction Management, summarized as follows:
|
Original Contract[18] |
Moving Services[19] |
Contract Renewal[20] |
Contract Extension[21] |
Moving Contract[22] |
Contract Extension[23] |
TOTAL |
Term |
2/2/02 – 2/28/04 |
8/23/02 – 2/28/04 |
3/1/04 – 8/31/05 |
10/1/05 – 6/30/06 |
5/05 – 9/05 |
7/1/06 – 12/31/06 |
|
Amount |
$1,205,104 |
$99,825 |
$958,058 |
$374,325 |
$27,254 |
$224,500 |
$2,889,066 |
Table 4. Approved Contracts for
Strategic Construction Management Paid by Bond Funds.
Response: Santa Cruz City Schools PARTIALLY
AGREES.
The original contract with Strategic Construction
management was based on the projects originally planned out of the $86 million
in E and H bond funds. The renewal and
subsequent extensions in the SCM contract were added when the District received
an additional $26.5 million in State SB50 funds. The District also added $15 million in other
District funds to the projects that increased the need for Strategic CM
services. Refer to attached spreadsheet
(Exhibit 3).
28. In
addition to bond funds, payments totaling $68,273 to Strategic Construction
Management have been approved by the SCCS Board: $48,221 from the General Fund
to “plan and coordinate moving of furniture, equipment and supplies (March 24,
2004); and $20,052 from the Capital Facilities Fund to “plan and coordinate the
relocation of 21 portable classrooms” (April 21, 2004).
Response: Santa Cruz City Schools PARTIALLY
AGREES.
These services were related to school reorganization and
consolidation and were not paid for with Bond funds (see Exhibit 3).
29. In
the RFP for Management Services for Construction Projects that was part of the
Strategic Construction Management Agreement with the district, one requirement
is to “plan and coordinate the moving of staff, furniture, material and
equipment related to the construction projects.” Strategic Construction
Management submitted a fixed fee proposal to secure this contract.
Response: Santa Cruz City Schools PARTIALLY
AGREES.
Strategic Construction Management’s original scope included
moving as it related to construction projects, such as moving classroom
furniture as part of on-going construction, and moving furniture and equipment
within a given campus as a result of work directly related to the Bond
construction projects. The increase in
services/fees were required for the management and coordination of moves at the
various construction sites beyond those considered in the District’s scope of
services as described in the Request for Proposals (RFP) for management
services for construction projects. The
Strategic Construction Management original fee proposal was based on the
District’s scope of services as described in the RFP. The District’s RFP was not specific regarding
the scope, phasing requirements and amount of time required to coordinate and
direct the moves at the numerous school sites.
Included in Strategic Construction Management’s scope of services and
fixed fee was 200 hours dedicated for planning and coordinating the moving of
staff, furniture, materials and equipment during construction. The allocated fee for this service was
$15,000.
At the time of the request for the fee increase, Strategic
Construction Management had expended approximately 390 hours related to the
moves. Strategic Construction Management
was providing services that included: preparing documents to solicit a minimum
of three (3) moving quotes, leading pre-quotation school site walks, receiving
quotations, developing phasing plans, meeting with staff and faculty to
determine packing needs, arranging for the delivery of cardboard boxes and
storage containers and being available to coordinate and facilitate moves.
In addition to the amount of time needed to support the
District with their moves, Strategic Construction Management had not been
provided with “full-time clerical support” as described in the RFP. Not having this support took Strategic staff
away from the duties they anticipated.
30. In
March 2002, the board approved a district Construction Projects Coordinator
position to serve as a liaison between Strategic Construction Management and
the district sites. The position is funded through the elementary and secondary
bonds. The head of the district Maintenance Department was appointed to the
position.
31.
The SCCS Board of
Education approved a resolution to no longer require a public re-bidding of
work once change orders exceeded the cost of the original bid by over ten
percent (10%), as had been previously required. It was stated that the re-bid
process can cause a six- to eight-week delay, and since the district had a
general contractor in charge of bond-funded projects, the chances of exceeding
a ten percent overrun were considerably less.
Response: Santa Cruz City Schools PARTIALLY
DISAGREES.

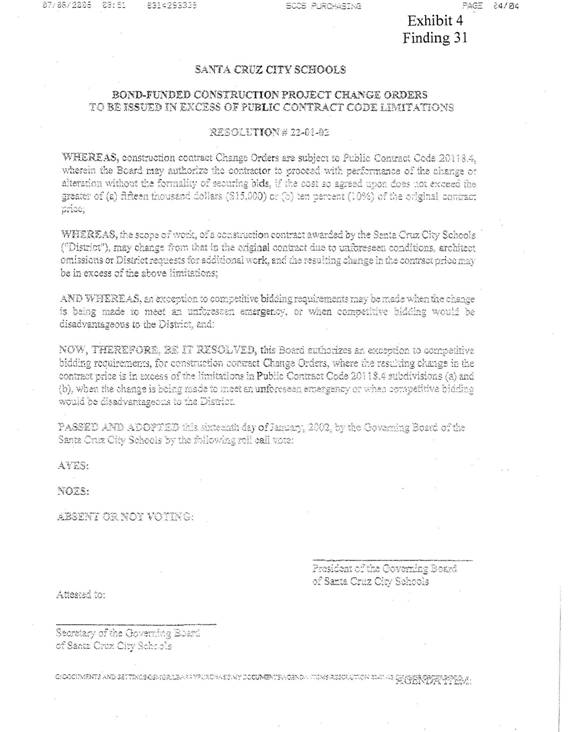

A copy of Board resolution #22-01-02
authorizing exceeding the 10% limit on change orders and the cover memo that
went to the Board with the resolution, are attached as Exhibit 4. Nowhere in the cover memo does it say that
the chances of exceeding the 10% limit were less because of having a general
contractor in charge of the construction projects, as alleged by the Grand Jury
in this finding.
There were two reasons that the Board
approved the resolution allowing change orders to exceed 10% of the original
bid. They were:
1.
The 10% threshold is reasonable on new construction
projects, but not on modernization projects on older buildings where there is
greater potential for finding problems during construction that need to be
addressed that could not be anticipated during the initial development of the
plans and specs for the project. Most of
our projects were renovation and modernization of older buildings. Most of the change orders were a result of unforeseen
conditions discovered during renovation or from additional work requested by
the District.
2.
Most of the construction projects were being done on
operating school facilities during the school year and were disruptive to
students and staff. If all change orders
that exceeded 10% of the original contract were bid, it would have (a) delayed
the projects, thereby prolonging the disruption of students and staff; and (b)
potentially resulted in delay claims from the original contractor if that
contractor was delayed in their ability to complete their contract waiting for
a second contractor to come in and complete separately bid change order
work. During the spring and summer of
2004, when the elementary and small schools were being reorganized, the timing
of completing the relocation of portables and getting schools ready for the
opening of school at the end of August was critical. If we had bid change orders separately at
that time, the schools would not have been ready for students in time for the
start of school.
When projects encounter unforeseen
conditions, it is never prudent or cost effective to stop the work, determine
the extent of the additional work required to proceed with the original work,
prepare bid documents for public bidding and publish them, conduct job walks
and accept bids. The costs to
investigate and then prepare the bid documents and publish the work would
outweigh the costs of continuing with the original contractor. The time delays of conducting the
investigation and bidding could be at least 5-6 weeks (at a minimum) before
work could commence. The costs for the
original contractor to pull off the job while the new contractor does their
work, and then re-mobilize their staff have not been factored. It makes complete sense to work with the
original contractor and expedite the work with one general contractor
responsible for coordination, payments, warranties, etc.
32.
The SCCS Bond Project, Status of Project Closeout,
May 10, 2006, revealed that out of sixty-nine projects, thirty-seven (or 54%)
exceeded a ten percent cost overrun due to change orders.
Response: Santa Cruz City Schools PARTIALLY
DISAGREES.
Most of the change orders that exceeded 10% of the
original bid were based on additional work requested by the District, or were
due to unforeseen conditions discovered during the construction process. Budget contingency reserves had been
established to cover these costs.
33.
In October 2005,
the SCCS Board voted to become subject to the Uniform Public Construction Cost
Accounting Procedures and to provide for informal bidding procedures under the
Uniform Public Construction Cost Accounting Act Procedures. This allowed
projects from $35,000 to $125,000 to be bid using a pre-approved list of
satisfactory contractors, while projects over $125,000 were subject to formal
bidding procedures. The rationale was that this would allow more flexibility in
the execution of work; speed up bidding procedures; improve timeliness of
project completion; reduce paperwork and expenses related to advertising; and
simplify administration.
34.
The SCCS District
was advised by legal counsel to set a consistent policy for the acceptance of
bids. Subsequently, it was decided to award contracts based on the lowest total
bid on each project. Projects often contain several alternates, which may or
may not be actually included in the final project. The contract, however, is
still awarded on the total bid.
Response: Santa Cruz City Schools PARTIALLY
AGREES.
Legal Counsel advice was based on the
methodology used to define lowest bid in conformance with Public Contract Code.
35.
When projects
contain alternates, contractors can bid low or even zero (0) on some
alternates, thereby lowering their overall total bid.
Response: Santa Cruz City Schools PARTIALLY
DISAGREES.
If a contractor bids low or zero on
the alternates and they have the lowest total bid that is accepted by the
District, they are still obligated to complete the alternates for the amount of
their bid.
36.
In March 2006, the
district awarded a bond project contract to a bidder whose past projects for
the district included a project that had change orders totaling 34.1% of the
original contact amount, a Stop Notice, and had gone to court. That same bidder
had previously completed district bond projects with change orders of 32.3%,
36.9%, and 118.8% of the original contract amounts.
Response: Santa Cruz City Schools PARTIALLY
DISAGREES.
This contractor was CRW Industries,
Inc. The cause of change orders on
previous CRW projects exceeding 10% of the original contract amount was
primarily due to the District requesting additional work and on unforeseen
conditions. The “Stop Notice” that was
filed on CRW was based on employees of a subcontractor filing a lawsuit against
the subcontractor over a pay dispute, and filing the Stop Notice to keep the
District from paying CRW so CRW could not pay the subcontractor until the pay
dispute was resolved with the subcontractor.
The Stop Notice
had nothing to do with any action by CRW.
CRW was the low bidder on the Santa
Cruz High School Kiln Building project at $131,792. The fact that CRW change orders on previous
projects exceeded 10% of the original contract amounts is not legal grounds for
declaring CRW a “not responsible” bidder on future projects.
37.
Contracts were not
always awarded to the lowest bidder as evidenced by Bid # 2006-09. The contract
was awarded for $1,204,700 when the lowest bid was actually $1,151,399.
Response: Santa Cruz City Schools PARTIALLY
DISAGREES.
Contracts are always awarded to the
lowest bidder as defined in section 10 of our Instructions to Bidders (Exhibit
5) which are based on Public Contract Code section 20103.8 (Exhibit 6), and
advice from District legal counsel (Exhibit 7).

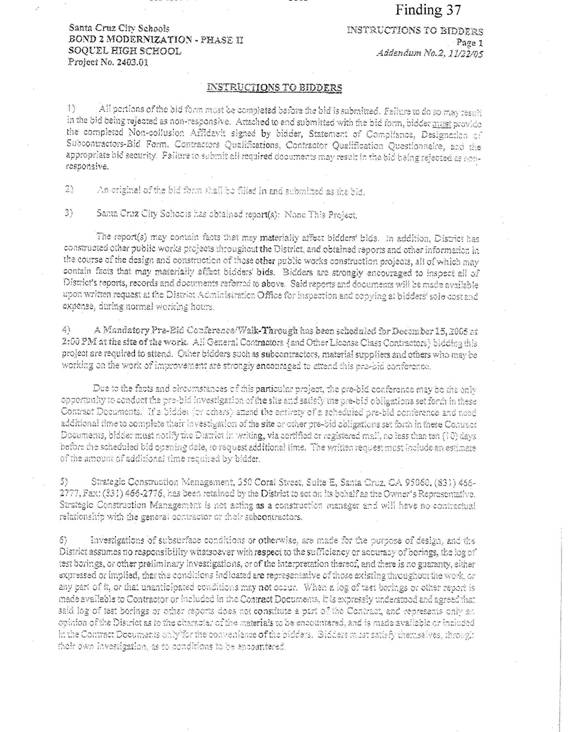

A copy of bid # 2006-09 (Exhibit 8) shows that, as defined in our bid
documents, Robert Bothman was the low bidder based on
the total bid with all alternates.
38.
The SCCS Bond Project, Status of Project Closeout, May
10, 2006, document does not include all bond projects, notably those undertaken
in 1998-1999. Approximately $4 million worth of projects are not detailed, nor
are their change orders.
Response: Santa Cruz City Schools PARTIALLY
AGREES.
The first projects were done in 1999. They were small projects consisting of
installing new play structures at the elementary schools, resurfacing the
Soquel High School student parking lot, installing an outdoor eating area cover
at Mission Hill, termite eradication at Branciforte
Junior High and installing new gym roofs at Santa Cruz High School and Harbor
High School. Many of these projects were
maintenance projects and did not require Department of the State Architect
approval. The project close-out report
was not started until the first round of major modernization projects were
begun in 2000 and began close-out in 2001.
The small early projects were not added to the report.
39. The SCCS, Bond Project, Status of Project Closeout, May 10, 2006, showed twenty projects with change orders exceeding twenty percent (20%) of the original project contract. These percentages range from 21.7% to 118.8%, resulting in additional costs of $5,479,544 above the original contract amount of $17,779,162 for those twenty projects. This reflected a 30.8% increase over the original contract amounts.
Response: Santa Cruz City Schools PARTIALLY AGREES.
For all projects listed on the 5/10/06 Status
of Project Close Report, total change order costs were $9,621,580, or 14.1% of
total original contract amounts of $68,468,271.
This is not an unreasonable average change order percentage for
renovation and modernization projects.
As mentioned in the response to Finding # 32, many of these change
orders were generated by District requests for additional work and additional
work required to correct unforeseen conditions.
40. Sixty-nine completed or nearly-completed projects detailed on the SCCS, Bond Project, Status of Project Closeout, May 10, 2006, had change orders totaling $9,621,580, or fourteen and one-half percent (14.5%) of their original contract total of $66,457,279.
Response: Santa Cruz City Schools DISAGREES.
See response to finding #39.
41.
District officials stated that general contractors
typically make a fifteen-percent markup on change orders.
Response: Santa Cruz City Schools AGREES.
The General Contractor’s 15% mark-up on change
orders is to cover the General Contractor’s bonds, insurance overhead and
profit, and was specified in the contract documents.
42. According
to the Santa Cruz City Schools, Bond Project, Status of Project Closeout, dated
May 10, 2006, sixty-four projects have had Notices of Completion filed. Of
those sixty-four projects, only one is listed in the “DSA Closeout
Complete” column, and only two are listed in the “Closeout Sent to DSA” column.
The Architect of Record is responsible
for submitting the required closeout documents for final certification.[24]
Response: Santa Cruz City Schools PARTIALLY AGREES.
The Bond Project
Status of Projects Close-Out Report of 7/12/06 (Exhibit 9 attached) indicates
that all project close-out documents have been submitted to DSA on twelve
projects. Eight of the projects listed
are still under construction and not ready for close-out document
submittal. Four projects have final DSA
close-out.
Final DSA close-out
can take from two to five years. Both
architect firms, DES and Beverly Prior, have staff that are actively working on
gathering and completing project close-out documents for submittal to DSA, and
are making regular reports to the District on their status. Close-out documents come from some material
suppliers, from portable classroom manufacturers, and from the IOR Once close-out
documents are received by DSA, it can take DSA staff as long as two years to
complete processing of those documents and closing out of the project files. This is due to understaffing at DSA.
43. The Grand Jury found at least one instance of
a project being started without prior DSA notification by the IOR (DSA Project
Code 01-106000). This appears to be a violation of the Code of Regulations,
Title 24, Part 1, Section 4-331.
Response:
Santa Cruz City Schools DISAGREES.
This was the Soquel High School Ag Facility
relocation project. The IOR’s (Fred Powers) Qualification Record DSA-5 was
submitted to DSA on 9/30/04. It was
approved by DSA on 10/4/04. The Contract
Information form SSS-102 was submitted to DSA on 11/1/04 and indicated that
work would start on 11/1/04. We recall
that work actually started around the first of December. This does not appear to be an accurate
statement.
44. Inspector
of Record assignment date records obtained from the SCCS District and the DSA
do not match.
Response: Santa Cruz City Schools PARTIALLY
DISAGREES.
The District was not provided copies of the
records provided to the Grand Jury by the DSA and therefore cannot comment on
this finding.
45. “The school board must provide for and require competent, adequate and continuous inspection by an inspector . . .” and; “The project inspector . . . must be approved by the DSA for each individual project.”[25]
46. In reviewing the IOR field reports for Santa
Cruz High Modernization, project number 01-103363, there is a gap of eighteen
days with no IOR reports or notations. One inspector had been terminated on May
2, 2002, and the next IOR report was dated May 20, 2002.
Response: Santa Cruz City Schools:
The Santa Cruz High
School Inspector was released for specified reasons. A second inspector was engaged but replaced
by the DSA Field Engineer. A third
inspector was subsequently replaced by a fourth inspector by the DSA Field
Engineer. Since only demolition was
underway and no structural or fire/life safety work was involved, lapse in
coverage was less stringent. DSA drove
the missing coverages due to their manipulation of
the inspector selection process – no fault of the District.
47. DSA Field Notes from the supervising field
engineer from July 10, 2002, stated the first item requiring resolution on
project 01-103363 was that the IOR had been replaced by two subsequent IORs, the last of which had not submitted DSA Form-5. The
DSA Form-5, which must be signed by the district, architect, and engineer, must
be filed ten days prior to an IOR beginning a project.[26]
Response: Santa Cruz City
Schools:
See the response to #46. DSA pulled inspectors from the project and, since no inspections were required or called for, no Form 5 was filed.
48.
In January 2001, the BOC questioned the prudence of
using bond funds to modernize schools that might be closed in the future due to
declining enrollment.
49.
In June 2004, Natural Bridges and Branciforte
Elementary schools closed. Branciforte became a campus for small district
alternative schools. Natural Bridges is leased by Pacific Collegiate, a charter
school that is funded by the state. This site is not being used as part of
Santa Cruz City Schools. Proposition 39 obligates the district to provide a
certain amount of space rent free since sixty percent of the students come from
within SCCS boundaries. Pacific Collegiate leases space for the forty percent
of the students from outside the district. The district also leases space to
another school, Carden El Encanto,
at the former Loma Prieta High School site. Lease funds go into the general
fund. Following is a summary of the current and projected lease income for
these two sites:[27]
LEASE REVENUES |
|||||
|
04-05 |
05-06 |
06-07 |
07-08 |
08-09 |
Natural Bridges |
$68,000 |
$83,232 |
$84,897 |
$86,595 |
$88,326 |
Loma Prieta |
$140,000 |
$165,000 |
$200,000 |
$228,400 |
$275,500 |
|
$208,000 |
$248,232 |
$284,897 |
$314,995 |
$363,826 |
Table 5. Santa Cruz City Schools Lease
Revenues, 2004-2009.
Response: Santa Cruz City Schools PARTIALLY AGREES.
The lease revenue in the table is reversed
for Natural Bridges and Loma Prieta.
50.
In August 2004, a citizen who attended two BOC meetings
expressed concern about bond funds that had been used on schools that were
later closed. The citizen felt that the lease money from those schools should
be used to reduce the bond debt.
Response: Santa Cruz City Schools AGREES.
The BOC discussed the citizen’s
recommendation, but felt that the amount of tax savings to the individual tax
payer would be an insignificant amount, whereas the amount of revenue loss to
the General Fund would be significant.
51.
District administrative staff reported to the BOC
committee that legal counsel said it was not illegal to lease out the renovated
schools and not use the revenues to defray the debt. The BOC approved a motion to not recommend using lease revenues to
retire bond debt.
Response: Santa Cruz City Schools AGREES.
The lease revenue is deposited to the General
Fund to support operating expenses at the schools. Transferring this revenue to reduce Bond debt
would require cuts in school budgets.
52.
Even after Natural Bridges and Branciforte elementary
schools had been closed, and the four alternative schools on three sites were
moved to the former Branciforte Elementary campus, the district still needed to
reduce overhead and save operating expenses due to declining enrollment. The
district offices on Mission Street were sold, and ten classrooms at Soquel High
School were chosen to serve as administrative offices (Soquel High School’s enrollment dropped from 1693 students in 1998
to 1234 students in 2005-06). The Adult Education Office, the Purchasing
Department, and District Warehouse were moved to Palm Street. The Workability
Program and Food Services Office were moved to DeLaveaga Elementary School.
Response: Santa Cruz City Schools PARTIALLY AGREES.
The sale of 2931 Mission Street and the
relocation of the District office occurred prior to the reorganization of the
schools. The Workability Office was
moved to Harbor High School.
53.
Classrooms identified to house the district offices at
Soquel High had already been remodeled using bond funds. At least an additional
$460,537 in bond money was spent for the district office remodel.
Response: Santa Cruz City Schools AGREES.
The additional cost was to convert
classrooms to office space, to add electrical, a telephone system, data wiring,
and to add parking.
54.
At its April 9, 2003 meeting, the SCCS Board approved
the use of up to $1 million in bond funds for district office relocation and
improvements. In its advisory capacity, the BOC did not recommend this action.
Response: Santa Cruz City Schools AGREES.
55. To
date, at least $1,285,486 of bond project money has been spent on district
office and adult education relocation. This total includes $274,424 for change
orders, or twenty-seven (27%) of the original contract amount of $1,011,062.
Response: Santa Cruz City Schools PARTIALLY AGREES.
$1,291,631 has been spent on District
Office/Adult Education relocation. Of
that amount, $280,659 was for change orders, 27.7% of the original contract
amounts.
56. A
BOC member called the use of bond money for offices “not ethical,” and stated that
the district could use anticipated redevelopment revenue to pay for the
classroom conversions and other relocation projects. “There was a promise (the
bond money) would never be used for administrative costs. It was to improve the
student environment, not the district office environment.”[28]
Response: Santa Cruz City Schools PARTIALLY AGREES.
The ballot measure said that Bond funds would
not be used for administrative salaries.
The District’s Bond Counsel advised the District that it would be a
legal use of the Bond funds, given the ballot language, for relocating District
Office facilities. Selling the old
District Office at 2931 Mission Street will save $400,000 per year in debt
service payments in the General Fund, which provides more operating funds for
schools and students.
57.
The BOC has been meeting bi-monthly since 1998. These
meetings are open to the public. Minutes and any reports released are public
information. Meetings are held at Soquel High School, Room 312. Oversight
committee members stated that meeting notices are posted at school sites and
the district office.
58.
In 1998, a bond web page was developed with links to
each school site providing regular updates on bond-related issues.
59.
In June 1999, the communications sub-committee of the
BOC worked on placing bond-related information on the SCCS web page. Signs
relating to bond projects were designed for placement at the school sites.
60. On
August 26, 1999, the BOC stated that the Board of Education, Bond Oversight
Committee, and district administration should work jointly to create a public
relations program and method of presentation for each school site, the press,
and the public in general.
Response: Santa Cruz City Schools AGREES.
The BOC has made repeated attempts to have
the stories about the Bond Projects reported in the press. The press has not responded favorably to
their attempts. We think that the school
sites have been kept informed. However,
the general public has not been very well informed because the press has been
unresponsive. The BOC has had discussions about how to handle this. Most of the ways the BOC could find to inform
the public involved the use of bond funds.
The BOC has been very reluctant to spend bond funds on mailings and
ads. The BOC has tried to ensure that
the money was used to the benefit of the students in the classroom.
61.
District staff and BOC members were interviewed for
“Community Express,” a Community Television of Santa Cruz show. The show aired
four times in Fall 1999 and outlined the school bond
issues and future project plans.
62.
A brochure “The Road to Renovation” detailed the status
of Measure E and H projects and was distributed to parents from the school
sites and mailed to households within the district in May 2000. This brochure
indicated there would be ongoing communication to keep the public aware of
progress and improvements.
63.
In July 2000, a Board of Education member noted that
the district’s web site was in need of updating.
64.
The Grand Jury observed that as late as October 17,
2005, there was a “Bond Projects” section on the Santa Cruz City Schools web
site. Information was out of date; the last update had been posted in 2001. By
February of 2006, that section of the web site was no longer accessible, and
posts “Forbidden: You don’t have permission to access … (this site) on this
server.”
Response: Santa Cruz City Schools PARTIALLY AGREES.
The District did not maintain detailed
information on the Bond Projects on the SCCS website. There were not adequate
resources dedicated to maintaining the SCCS website, including the Bond Projects
information on the website. However, the SCCS website had a link to the
Strategic Construction Management (SCM) website, where information on projects
at each school site was available. When the District website was redesigned in
September 2005, the link to SCM was inadvertently omitted. It was reinstated on
9/26/06.
Without knowing specifically which website the
Grand Jury attempted to access when receiving the “Forbidden: You don’t have permission to access…”
message, it is difficult to respond to why that message was received. That message is a standard response on any
web server when a web page cannot be found.
65.
When asked about the inaccessibility of the web site,
district staff responded that the webmaster worked one half-day per week and
that there were no resources in the district to put more effort into the web
site.
Response: Santa Cruz City Schools AGREES.
66.
Strategic Construction Management publishes SCCS site
construction newsletters on its web site. Newsletters for completed bond
projects include construction budget summaries, schedules, and architect,
inspector, and contractor information. Web site summaries of current projects
have none of this information.[29]
Response: Santa Cruz City Schools AGREES.
67.
The construction budget summaries for “Completed
Projects” on the Strategic Construction Management web site do not match the
figures printed on the Santa Cruz City
Schools Bond Project, Status of Project Closeout, May10, 2006. The Strategic
Construction Management web site is the only one displaying information on the
SCCS bond construction projects.
Response: Santa Cruz City Schools AGREES.
The costs reported on the website include hard costs and soft
costs (architect fees, DSA fees, IOR fees, bidding costs). The costs reported
on the Project Close-out Report are only hard costs paid to contractors.
68.
According to district administrative staff, by the end
of summer 2006, ninety-eight percent (98%) of bond funds will be spent. The
BOC’s final meeting is scheduled for November 2006. If there is any money left
over, district staff will oversee expenditures. Construction projects could
extend into Spring 2007.
Response: Santa Cruz City Schools AGREES.
The only
remaining project after November, 2006, will be the new Santa Cruz High School
swimming pool projects that will be funded 50% with Bond Funds.
69. Strategic
Construction Management will be paid $34,500 to produce a Bond Projects Report.
This fee is included in their July 1, 2006 to December 31, 2006 contract
extension.
Response: Santa Cruz City Schools DISAGREES.
This was a proposal based on ill-defined
scope and provided to the BOC for discussion purposes. This was never approved.
70.
At its May 18, 2006 meeting, the BOC reviewed options
for its final committee report which may be in the form of newspaper ads or
inserts, postcards, a newsletter, a twenty-four page report, or a video.
Response: Santa Cruz City Schools AGREES.
1. Measure E, Series A, B, and C bond sales
exceeded the voter-approved amount of $28 million by $98,115.65. The $28
million cap was exceeded a second time when the Measure E, Series A and B bonds
were refinanced, this time by $383,115.65.
2. A savings of over $3 million in interest is
projected due to the refinancing of the Elementary and High School Bonds,
Series A and B that were sold for $4,280,000 million more than the principal
remaining. Although interest was decreased, the total debt was increased. The
purpose of the refinancing appears to be to extract more funds and not to lower
property taxes.
3. The 2005 refinancing of the Elementary and
High School Bonds is not shown on the SCCS Bond Projects Budget, Report from
July 1, 1998 to April 30, 2006. Voters are entitled to full disclosure
regarding all bond details.
4. Contrary to the language of the Voter
Information Pamphlet, the bond terms of both the Elementary and High School
bonds are greater than twenty-five years.
5. Property owners in the Santa Cruz City
Schools District are paying a higher percentage of their property taxes to
repay bonds E and H in the 2005-2006 tax year than
they paid in the 2004-2005 tax year. To date, the decreased bond interest rates
have not reduced property taxes.
6. Over the next twenty-three years, property
tax deposits will earn interest that could be used to reduce bond debt.
7. The SCCS District has exceeded its fiscal
authority granted in Measures E and H by selling bonds for more than the
voter-approved limit. By so doing, it could make it more difficult for voters
to approve future bond projects.
8. As of April 30, 2006, expenses for
architects/engineers, and construction management total sixteen percent (16%)
of the total bond project expenditures, or over $18 million.
9. The district did not have personnel on staff
with adequate construction knowledge to manage large construction projects.
10. The district could not find an efficient and
cost-effective method of construction program management. There were many
layers of construction supervision and coordination paid for with bond dollars:
general contractors, architects, Strategic Construction Management, and the
district’s Construction Program Coordinator.
11. Originally, the Strategic Construction
Management contract was for $1.2 million and all projects were to be completed
by December 2004. By the end of 2006, payments to Strategic Construction
Management will reach nearly $3 million, and projects are still continuing.
12. Additional payments were made to Strategic
Construction Management for moving services that were part of their original
contract with SCCS for which a fixed-price bid had been submitted.
13. Total bond project construction management
fees from 1998 to present appear excessive, and will top $7 million before the
end of 2006.
14. The bidding process for the Construction
Program Manager was not conducted according to Public Contract Code Procedures.
Bid documentation is not available from the district to determine whether the
lowest bidder was accepted; and documentation that the bids were opened in
public as mandated by the Public Contract Code has not been made available by
the district.
15. When the board voted to no longer require
re-bidding projects that surpassed the ten percent change order threshold, it
removed the cap on change orders.
16. A contractor should not have been considered
“responsible” if that contractor’s previous jobs had excessive change orders
and if court action was necessary.
17. When projects were bid with alternates, this
allowed contractors to manipulate the system by giving a low bid or zero on
alternates, thereby allowing a contractor to submit the lowest bid. The bid
would not necessarily be awarded to a responsible bidder.
18. The SCCS Bond Project, Status of Project
Closeout, May 10, 2006 is incomplete; therefore, a true assessment of costs and
overruns cannot easily be made.
19. The amount of change orders appears
excessive. This could be due, in part, to the removal of the ten percent (10%)
cap requiring project re-bidding.
20. There was no financial incentive for
contractors and architects to keep change orders to a minimum.
21. The Architects of Record have not fulfilled
their responsibilities to secure project closeout and certification by the DSA.
22. District administrative staff has not seen
the projects through to closeout by insisting that the Architects of Record
submit all closeout documentation.
23. The district, architect, and engineer failed
to file DSA Form-5 before IORs started project
01-103363 as required by the California Code of Regulations.
24. IOR documentation for project 01-103363 is
incomplete and shows a gap of eighteen days with no IOR site notations or
reports. It is a violation of the California Code of Regulations for a project
to proceed without an IOR.
25. Since district and DSA documentation of IOR
assignments and dates do not match, the Grand Jury was unable to determine
whether projects progressed without an assigned IOR, or without a DSA-approved
IOR.
26. Although bond funds were used to renovate the
Natural Bridges and Loma Prieta sites, lease revenues
have not been used to repay bond debt.
27. Despite the fact that the Voter Information
Pamphlet arguments in favor of the bond measures clearly stated that bond funds
were not to be used for administrative offices, the SCCS Board used bond funds
for this purpose.
28. The SCCS Board ignored BOC recommendations
not to use bond funds for district office renovations and relocation.
29. Lack of planning resulted in wasted money at
Soquel High when ten classrooms that had already undergone renovation and
modernization were remodeled for district offices.
30. The SCCS District spent more than $1.2
million on district office renovations and relocations. The district inappropriately
approved $1 million for this purpose; no bond money should have been used.
31. The BOC is scheduled to disband in November
2006. Projects may continue until at least Spring 2007, and there will be no
BOC oversight. Bonds were passed under the assumption that an oversight
committee would be in place for the duration of the projects.
32. The district has not maintained the bond
project information on its web site. This could have been a valuable means of
providing ongoing, up-to-date public information on the bond projects.
33. Over the last eight years, there has been no
ongoing form of public communication with district residents regarding the bond
projects. Efforts made, such as starting a web page, being interviewed for
Santa Cruz Community Television, and producing a brochure, all took place
between 1998-2000.
34. As of this late date, the BOC has not yet
determined the format and scope of its final report. The Grand Jury questions
whether this will give the BOC time to prepare a comprehensive report.
35. Paying
Strategic Construction Management $34,500 to help prepare a final report
detailing the bond projects could result in a loss of objectivity and detail in
evaluating the projects’ successes and failures.
1. The
Grand Jury recommends that the Santa Cruz County Auditor initiate an outside,
independent audit to scrutinize the bond sales and refinancing, and expenditure
of bond funds. If there was surplus cash gained from the refinancing, it should
be accounted for and used to reduce the bond debt.
Response: Santa Cruz County Auditor-Controller PARTIALLY DISAGREES.
The
County Auditor-Controller does not generally have authority to audit School
District activities. The County
Auditor-Controller is generally responsible for the fiscal oversight of County
functions or those under the Board of Supervisor’s control. However, if a district has funds in the
County treasury, the Board of Supervisors can direct the Auditor-Controller to
perform an audit of that district as well.
California Government Code Section 26883 states:
In
addition to the power now possessed by the Board of Supervisors to enter into
contracts for audits, the Board shall have the power to require that the County
Auditor-Controller shall audit the accounts and records of any department,
office, board or institution under its control and of any district whose
funds are kept in the County treasury. . .
Nevertheless, the issues raised in this Grand Jury report are important
and should be addressed. The County Auditor-Controller
has communicated with Santa Cruz City Schools District staff to research and
respond to the findings and recommendation contained in this reply. Unfortunately, the School District’s reply is
not due for another 30 days.
Consequently, the response to a few of the findings in this report are
incomplete, particularly Findings 7 and 10 regarding the legal cap on the
amount of the refunding bonds and the 29 year life of the bonds. Hopefully, the School District’s response
will include an independent legal opinion that the issues raised in Findings 7
and 10 are within the confines of the law.
Response: Santa Cruz City Schools PARTIALLY AGREES.
If the County Auditor decides to audit the
bond sales and refinancing, the District will cooperate with the County
Auditor. The District did not realize
any surplus cash from the refinancing.
The refinancing did reduce the bonded debt.
2.
An outside, independent performance audit should be
conducted to analyze, assess, and report on the Santa Cruz City Schools
District’s operational and construction management policies, procedures, and
practices regarding Bond Measures E and H. Investigation as to whether all
California Code of Regulations, Title 24 standards were followed should be
included.
Response: Santa Cruz City Schools DISAGREES.
The District will not conduct an independent
performance audit of the construction program for the following reasons:
1.
The Board and the BOC have been satisfied with the program.
2.
The schools have been satisfied with the outcome of the
projects.
3.
The Bond projects are nearly complete. There would be no future projects to which to
apply any recommendations from a performance audit.
4.
Low priority for the expenditure of funds for an audit.
The plans and
specifications for the projects were approved by the DSA before bidding to
ensure compliance with Title 24.
DSA-certified inspectors inspected the projects during construction to
ensure plans and specifications were followed by the contractors.
3.
The SCCS District should insist that the architects
submit all documents related to completed bond projects under DSA supervision
so the projects can be certified and closed out. Architect fees should be
withheld until DSA certification is complete.
Response: Santa Cruz City Schools PARTIALLY AGREES.
The District is insisting that the architects
submit all documents on completed projects so the projects can be closed out by
the DSA. The current architect contracts
do not provide for withholding of fees pending completion of final DSA project
close-out.
4.
For future major construction projects, the SCCS
District should consider hiring an experienced, qualified construction project
manager or team as a limited-term district employee(s). This would cost less
than hiring a construction management firm.
Response: Santa Cruz City Schools PARTIALLY AGREES.
For future major construction projects, the
District will consider hiring an experienced qualified construction project
manager or team as limited-term District employees. It is not clear that this would cost less or
be more effective than hiring a construction management firm. The BOC has been very satisfied with the
decision to engage the services of Strategic Construction Management.
5.
The SCCS District should replace the funds used for
District Office relocation and renovation to reduce bond debt.
Response: Santa Cruz City Schools DISAGREES.
See response to Finding # 56.
6.
The SCCS District should use lease revenues and
interest on future property tax collections to reduce the bond debt.
Response: Santa Cruz City Schools DISAGREES.
See response to Finding # 51.
7.
The SCCS District should provide a complete bond
projects budget document that includes bond refinancing details.
Response: Santa Cruz City Schools DISAGREES.
See response to Finding # 8.
8.
The SCCS District should provide a complete bond
projects closeout document detailing all bond construction projects.
Response: Santa Cruz City Schools AGREES.
The Bond Oversight Committee will produce a
final report of the Bond Projects by November 2006.
9.
Future construction
projects should be awarded to the contractor submitting the lowest base bid.
Alternates should be bid separately.
Response: Santa Cruz City Schools DISAGREES.
The process being used complies with Public
Contract Code and has been approved by District legal counsel.
10.
For future
construction projects, the contractors hired should adhere to the ten-percent
cap on change orders previously in effect.
Response: Santa Cruz City Schools DISAGREES.
Future modernization projects may require
exceeding the 10% change order threshold for the reasons outlined in the
response to Findings # 31 and 32.
11.
The SCCS District
should provide an objective summary and analysis of bond projects from beginning
to end. This should include project details, budget, and completion dates;
financial accounting; analysis of successes and failures; and suggestions for
improvement for any future bond or construction projects.
Response: Santa Cruz City Schools PARTIALLY AGREES.
The District has provided on-going bi-monthly
reports to the Board and BOC, including project status and budget status. These reports are available to anyone
interested in them. The BOC will produce
a final report on all of the projects by November, 2006.
12.
The SCCS District
should make sure its web site is comprehensive and updated frequently. The
final bond projects report and analysis should be posted on that web site.
Response: Santa Cruz City Schools AGREES.
Financial resources will first need to be
identified to fund the regular updates of the District’s web site. The Bond Projects Final Report will be
available on the District web site.
13.
The BOC should
continue to operate until all bond projects are completed.
Response: Santa Cruz City Schools DISAGREES.
The BOC has recommended and the Board has
approved that the last BOC meeting will be on November 16, 2006. The only construction project that will
continue after that date will be the Santa Cruz High School swimming pool. The Board and the BOC do not think that the
BOC needs to continue to meet to oversee one project that is funded 50% by Bond
Funds.
14. District support staff is to be commended for its helpfulness, promptness, and courtesy when providing requested documentation.
Entity |
Findings |
Recommendations |
Respond Within |
Santa Cruz City Schools Board of Trustees |
2-12, 14, 15, 19, 20, 23, 24, 27-29, 31, 32, 34-44, 46, 47, 51, 53-56, 64-70 |
1-13 |
90 Days (October 1, 2006) |
Santa Cruz County Auditor/Controller |
1-15 |
1 |
60 Days (September 1, 2006) |
Appendix A – Source Details
Santa Cruz City Schools, Board of Education for the Elementary and Secondary Districts Minutes:
May 12, 1999.
May 26, 1999.
June 9, 1999.
June 28, 1999.
July 14, 1999.
August 11, 1999.
August 18, 1999.
August 25, 1999.
September 8, 1999.
September 22, 1999.
October 13, 1999.
October 27, 1999.
November 17, 1999.
December 8, 1999.
January 12, 2000.
January 26, 2000.
February 9, 2000.
February 23, 2000.
March 15, 2000.
March 29, 2000.
April 13, 2000.
April 26, 2000.
May 10, 2000.
May 24, 2000.
June 7, 2000.
June 28, 2000.
July 12, 2000.
August 3, 2000.
August 16, 2000.
September 6, 2000.
September 20, 2000.
October 11, 2000.
October 25, 2000.
November 8, 2000.
November 29, 2000.
December 13, 2000.
January 17, 2001.
January 31, 2001.
February 6, 2001.
February 14, 2001.
February 28, 2001.
March 14, 2001.
March 28, 2001.
April 25, 2001.
May 9, 2001.
May 23, 2001.
June 6, 2001.
June 27, 2001.
July 11, 2001.
August 8, 2001.
August 22, 2001.
September 12, 2001.
September 26, 2001.
October 24, 2001.
November 7, 2001.
November 28, 2001.
December 5, 2001.
December 19, 2001.
January 16, 2002.
January 23, 2002.
January 30, 2002.
February 13, 2002.
February 20, 2002.
March 13, 2002.
March 27, 2002.
April 17, 2002.
May 8, 2002.
May 22, 2002.
June 6, 2002.
July 9, 2002.
August 14, 2002.
August 28, 2002.
September 11, 2002.
September 25, 2002.
October 2, 2002.
October 9, 2002.
October 23, 2002.
November 6, 2002.
November 13, 2002.
November 20, 2002.
December 11, 2002.
January 15, 2003.
January 29, 2003.
February 11, 2003.
February 12, 2003.
February 26, 2003.
March 5, 2003.
March 12, 2003.
March 26, 2003.
April 9, 2003.
April 30, 2003.
May 9, 2003.
May 14, 2003.
June 25, 2003.
July 23, 2003.
August 6, 2003.
August 27, 2003.
September 10, 2003.
September 24, 2003.
October 8, 2003.
October 22, 2003.
November 5, 2003.
November 10, 2003.
December 10, 2003.
January 14, 2004.
January 28, 2004.
February 11, 2004.
February 25, 2004.
March 10, 2004.
March 24, 2004.
April 21, 2004.
May 5, 2004.
May 12, 2004.
May 26, 2004.
June 9, 2004.
June 16, 2004.
June 29, 2004.
August 11, 2004.
August 21, 2004.
September 8, 2004.
September 22, 2004.
October 13, 2004.
October 27, 2004.
November 10, 2004.
December 15, 2004.
January 12, 2005.
February 9, 2005.
February 23, 2005.
March 9, 2005.
April 13, 2005.
April 20, 2005.
April 27, 2005.
May 25, 2005.
June 8, 2005.
June 20, 2005.
July 27, 2005.
August 10, 2005.
August 24, 2005.
September 14, 2005.
September 28, 2005.
October 10, 2005.
October 26, 2005.
November 21, 2005.
December 14, 2005.
January 9, 2006.
January 25, 2006.
February 8, 2006.
February 22, 2006.
March 8, 2006.
March 22, 2006.
April 19, 2006.
April 26, 2006.
May 10, 2006.
Santa Cruz City Schools Bond Oversight Committee Meeting Minutes:
May 16, 1998.
June 25, 1998.
July 20, 1998.
September 30, 1998.
December 10, 1998.
January 21, 1999.
March 4, 1999.
April 22, 1999.
June 24, 1999.
August 26, 1999 (agenda packet).
September 30, 1999.
October 28, 1999.
January 27, 2000 (agenda packet).
March 30, 2000.
May 18, 2000.
May 18, 2000 (revised).
June 22, 2000.
June 22, 2000 (revised).
July 20, 2000.
July 20, 2000 (revised).
September 21, 2000.
October 19, 2000.
November 16, 2000.
January 18, 2001.
March 22, 2001.
May 17, 2001.
July 19, 2001.
September 20, 2001.
October 11, 2001.
October 23, 2001.
November 15, 2001.
November 29, 2001.
December 5, 2001.
January 17, 2002.
March 21, 2002.
May 16, 2002.
July 11, 2002.
September 12, 2002.
September 19, 2002.
October 2, 2002.
November 21, 2002.
January 23, 2003.
March 20, 2003.
May 22, 2003.
June 12, 2003.
July 10, 2003.
September 18, 2003.
November 13, 2003.
November 20, 2003.
January 22, 2004.
March 19, 2004.
May 20, 2004.
August 5, 2004 (agenda packet).
September 16, 2004.
November 4, 2004.
November 18, 2004 (agenda packet).
January 20, 2005.
March 15, 2005.
April 7, 2005.
May 19, 2005.
July 21, 2005.
September 22, 2005.
November 17, 2005 (agenda packet).
January 19, 2006 (agenda packet).
March 16, 2006 (agenda packet).
May 18, 2006 (agenda packet).
Santa Cruz City
School District Bond Projects Status Reports:
November 17, 1999.
February 9, 2000.
April 13, 2000.
May 24, 2000.
August 2, 2000.
September 6, 2000.
October 11, 2000.
March 28, 2001.
April 25, 2001.
August 8, 2001.
October 10, 2001.
October 24, 2001.
November 7, 2001.
November 28, 2001.
March 27, 2002.
May 22, 2002.
August 14, 2002.
September 25, 2002.
December 11, 2002.
February 12, 2003.
March 26, 2003.
May 28, 2003.
August 6, 2003.
September 24, 2003.
December 10, 2003.
February 11, 2004.
March 24, 2004.
June 16, 2004.
September 22, 2004.
January 26, 2005.
April 13, 2005.
May 25, 2005.
July 27, 2005.
September 28, 2005.
January 25, 2006.
[1] County of Santa Cruz Sample Ballot and Voter Information Pamphlet for Special School District Election, Tuesday, April 14, 1998.
[2] County of Santa Cruz Sample Ballot and Voter Information Pamphlet for Special School District Election, Tuesday, April 14, 1998.
[3] Figures supplied by the Santa Cruz County Auditor/Controller Office, June 2, 2006.
[4] Santa Cruz City Schools, Bond Projects Budget, Report from July 1, 1998 to April 30, 2006.
[5] California Public Contract Code, http://www.aroundthecapitol.com/code/contents.html?sec=pcc.
[6] Santa Cruz City Schools, “Bond Oversight Committee Roles and Responsibilities,” revised April 17, 2002.
[7] Official Statements, Santa Cruz City Elementary School District, General Obligation Bonds, Election of 1998, Series A, B, and C; Official Statements, Santa Cruz City High School District, General Obligation Bonds, Election of 1998, Series A, B, C; Official Statement, Santa Cruz City Elementary School District, 2005 General Obligation Refunding Bonds; Official Statement, Santa Cruz City High School District, 2005 General Obligation Refunding Bonds.
[8] Official Statement, Santa Cruz City Elementary School District, 2005 General Obligation Refunding Bonds; Official Statement, Santa Cruz City High School District, 2005 General Obligation Refunding Bonds.
[9] County of Santa Cruz Sample Ballot and Voter Information Pamphlet for Special School District Election, Tuesday, April 14, 1998.
[10] California Education Code, Section 15144, http://caselaw.lp.findlaw.com/cacodes/edc.html.
[11] Santa Cruz City Schools, Bond Projects Budget, Report from July 11, 1998 to April 30, 2006.
[12] Santa Cruz City Schools, Bond Projects Budget, Report from July 11, 1998 to April 30, 2006.
[13] Santa Cruz City Schools, Request for Proposals, Management Services for Construction Projects, 2001.
[14] “Advantages/Disadvantages of Using Multiple Prime v. Single General Contractor, agenda packet, Bond Oversight Committee meeting, January 27, 2000.
[15] Santa Cruz City School Bond Oversight Committee Meeting Minutes, November 15, 2001.
[16] California Public Contract Code, Section 10180, http://www.aroundthecapitol.com/code/contents.html?sec=pcc
[17] Santa Cruz Sentinel, “Firm will oversee school construction projects,” February 15, 2002.
[18] Santa Cruz City Schools, Board of Education for the Elementary and Secondary Districts Minutes, February 27, 2002.
[19] Santa Cruz City Schools, Board of Education for the Elementary and Secondary Districts Minutes, August 14, 2002.
[20] Santa Cruz City Schools, Board of Education for the Elementary and Secondary Districts Minutes, December 10, 2003.
[21] Santa Cruz City Schools, Board of Education for the Elementary and Secondary Districts Minutes, June 8, 2005
[22] Santa Cruz City Schools, Board of Education for the Elementary and Secondary Districts Minutes, June 8, 2005.
[23] Santa Cruz City Schools, Board of Education for the Elementary and Secondary Districts Minutes, April 26, 2006.
[24] 2001
California Building Standards Administrative Code, California Code of
Regulations, Title 24,
Part 1, Sections 4-339 and 4-341, http://www.bsc.ca.gov/title_24/documents/Part1/2001_part1.pdf.
[25] 2001
California Building Standards Administrative Code, California Code of
Regulations, Title 124,
Part 1, Section 4-333(b).
[26] California Department of General Services, Division of the State Architect, Project Inspector Qualification Record, DSA-5, revised, March 27, 2003.
[27] Agenda Packet, Santa Cruz City Schools, Bond Oversight Committee Meeting, November 18, 2004.
[28] Santa Cruz Sentinel, “Moving costs stir school-bond debate,” May 29, 2003.
[29] Strategic Construction Management, http://strategic-cm.com/main/santacruzcityschools.htm.
